AGENDA

Finance & Audit Committee

Susan Baty (Chairperson)

Karen Naylor (Deputy Chairperson)

Grant Smith (The Mayor)

Vaughan Dennison

Lorna Johnson

Renee Dingwall

Bruno Petrenas

Lew Findlay QSM

Aleisha Rutherford

Patrick Handcock ONZM

Stephen Armstrong

Leonie Hapeta

PALMERSTON NORTH CITY COUNCIL

Finance & Audit Committee MEETING

26 May 2021

Order of Business

1.         Apologies

2.         Notification of Additional Items

Pursuant to Sections 46A(7) and 46A(7A) of the Local Government Official Information and Meetings Act 1987, to receive the Chairperson’s explanation that specified item(s), which do not appear on the Agenda of this meeting and/or the meeting to be held with the public excluded, will be discussed.

Any additions in accordance with Section 46A(7) must be approved by resolution with an explanation as to why they cannot be delayed until a future meeting.

Any additions in accordance with Section 46A(7A) may be received or referred to a subsequent meeting for further discussion.  No resolution, decision or recommendation can be made in respect of a minor item.

3.         Declarations of Interest (if any)

Members are reminded of their duty to give a general notice of any interest of items to be considered on this agenda and the need to declare these interests.

4.         Public Comment

To receive comments from members of the public on matters specified on this Agenda or, if time permits, on other Committee matters.

(NOTE:     If the Committee wishes to consider or discuss any issue raised that is not specified on the Agenda, other than to receive the comment made or refer it to the Chief Executive, then a resolution will need to be made in accordance with clause 2 above.)

5.         Confirmation of Minutes                                                                                     Page 7

“That the minutes of the Finance & Audit Committee meeting of 28 April 2021 Part I Public be confirmed as a true and correct record.”

6.         Assurance Report on Review of COVID-19 Expenditure                                  Page 13

Memorandum, presented by Masooma Akhter, Business Assurance Manager.

7.         Assurance Report on Review of Community Grants and Events Funding       Page 19

Memorandum, presented by Masooma Akhter, Business Assurance Manager and Sheryl Bryant, Acting General Manager - Marketing and Communications.

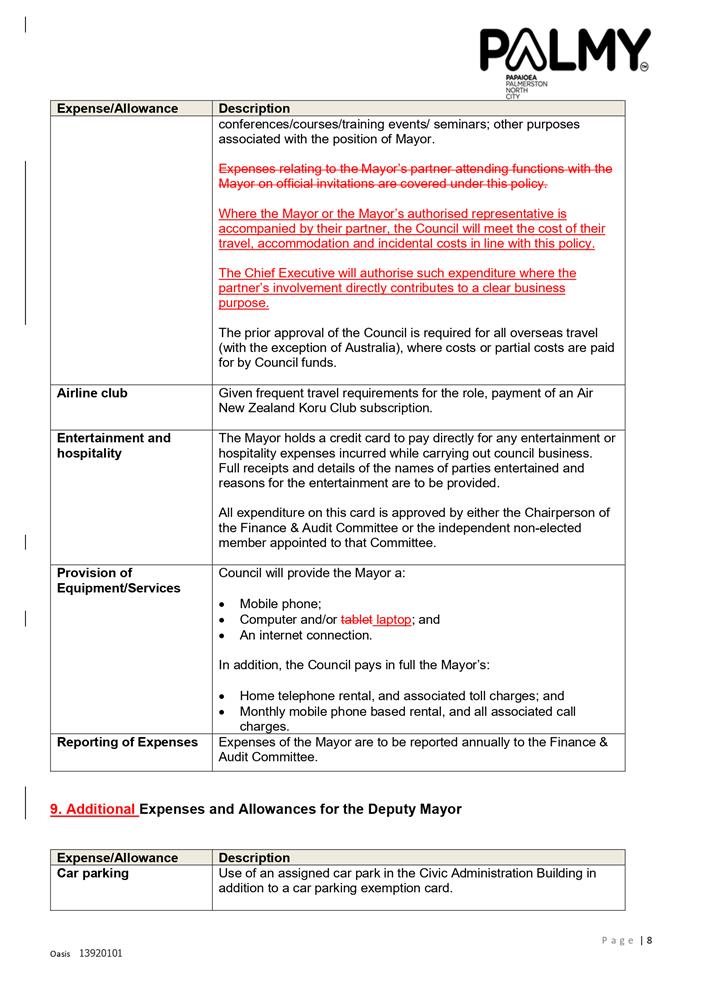

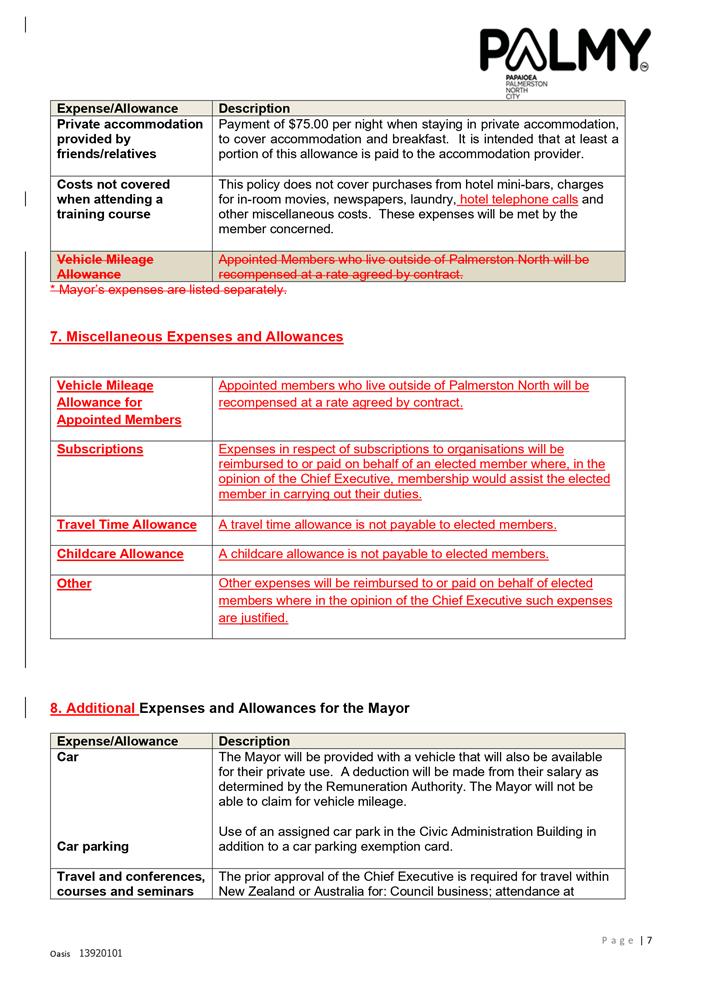

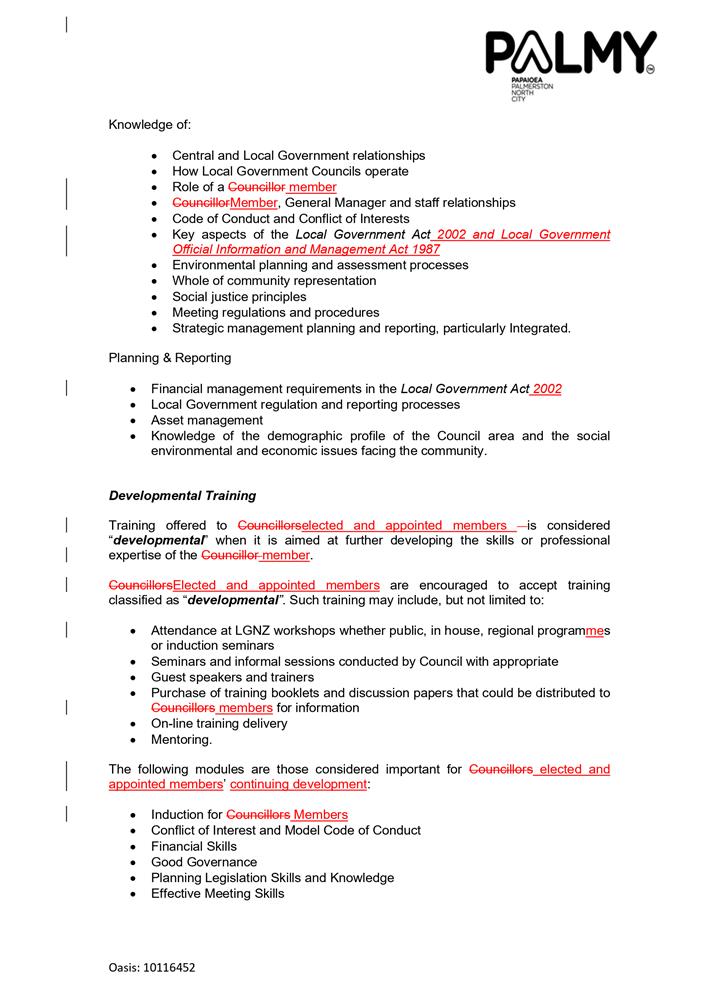

8.         Review of the Elected Members' Expenses and Allowances Policy 2021, and the Elected and Appointed Members' Professional Development & Training Policy 2021 Page 31

Memorandum, presented by Hannah White, Democracy & Governance Manager.

9.         Victoria Esplanade Bonsai/Shade House Project Options                               Page 55

Report, presented by Kathy Dever-Tod, Parks and Reserves Manager.

10.       Committee Work Schedule                                                                                Page 89

11.       Exclusion of Public

To be moved:

“That the public be excluded from the following parts of the proceedings of this meeting listed in the table below.

The general subject of each matter to be considered while the public is excluded, the reason for passing this resolution in relation to each matter, and the specific grounds under Section 48(1) of the Local Government Official Information and Meetings Act 1987 for the passing of this resolution are as follows:

General subject of each matter to be considered

Reason for passing this resolution in relation to each matter

Ground(s) under Section 48(1) for passing this resolution

12.

Minutes of the Finance & Audit Committee meeting - Part II Confidential - 28 April 2021

For the reasons setout in the Finance & Audit Committee minutes of 28 April 2021, held in public present.

13.

Award of Contract 3910 for Seismic Strengthening of the Turitea Water Treatment Plant

Commercial Activities and Negotiations

s7(2)(h) and s7(2)(i)

This resolution is made in reliance on Section 48(1)(a) of the Local Government Official Information and Meetings Act 1987 and the particular interest or interests protected by Section 6 or Section 7 of that Act which would be prejudiced by the holding of the whole or the relevant part of the proceedings of the meeting in public as stated in the above table.

Also that the persons listed below be permitted to remain after the public has been excluded for the reasons stated.

[Add Third Parties], because of their knowledge and ability to assist the meeting in speaking to their report/s [or other matters as specified] and answering questions, noting that such person/s will be present at the meeting only for the items that relate to their respective report/s [or matters as specified].

PALMERSTON NORTH CITY COUNCIL

Palmerston North City Council

Minutes of the Finance & Audit Committee Meeting Part I Public, held in the Council Chamber, First Floor, Civic Administration Building, 32 The Square, Palmerston North on 28 April 2021, commencing at 9.01am

Members

Present:

Councillor Susan Baty (in the Chair), Councillors Vaughan Dennison, Renee Dingwall, Lew Findlay QSM, Patrick Handcock ONZM, Lorna Johnson, Karen Naylor, Bruno Petrenas, Aleisha Rutherford and Mr Stephen Armstrong.

Non Members:

Councillors Brent Barrett, Rachel Bowen, Zulfiqar Butt, Billy Meehan and Orphée Mickalad.

Apologies:

The Mayor (late arrival on Council business) and Councillor Leonie Hapeta.

Note:  Councillor Patrick Handcock ONZM attended the meeting via audio visual link.

Councillor Vaughan Dennison declared a conflict of interest in Item 14 (clause 37) and was not present for this item.

The Mayor (Grant Smith) entered the meeting at 9.55am during consideration of clause 33.  He was not present for clauses 27 to 32 inclusive.

27-21

Apologies

Moved Susan Baty, seconded Vaughan Dennison.

The COMMITTEE RESOLVED

1.   That the Committee receive the apologies.

Clause 27-21 above was carried 15 votes to 0, the voting being as follows:

For:

Councillors Susan Baty, Brent Barrett, Rachel Bowen, Zulfiqar Butt, Vaughan Dennison, Renee Dingwall, Lew Findlay QSM, Patrick Handcock ONZM, Lorna Johnson, Billy Meehan, Orphée Mickalad, Karen Naylor, Bruno Petrenas, Aleisha Rutherford and Mr Stephen Armstrong.

28-21

Confirmation of Minutes

Moved Susan Baty, seconded Vaughan Dennison.

The COMMITTEE RESOLVED

1.   That the minutes of the Finance & Audit Committee meeting of 24 March 2021 Part I Public be confirmed as a true and correct record.

Clause 28-21 above was carried 14 votes to 0, with 1 abstention, the voting being as follows:

For:

Councillors Susan Baty, Brent Barrett, Rachel Bowen, Zulfiqar Butt, Vaughan Dennison, Renee Dingwall, Lew Findlay QSM, Patrick Handcock ONZM, Lorna Johnson, Billy Meehan, Orphée Mickalad, Karen Naylor, Bruno Petrenas and Mr Stephen Armstrong.

Abstained:

Councillor Aleisha Rutherford.

29-21

Ashhurst Domain - Scout Hall Lease Proposal

Report, presented by Kathy Dever-Tod, Manager - Parks and Reserves and Bryce Hosking, Manager - Property.

Moved Aleisha Rutherford, seconded Karen Naylor.

The COMMITTEE RECOMMENDS

1.   That Council approve the lease to The Scouts Association of New Zealand for the Ashhurst Scouts to operate from the Ashhurst Domain, attached as Appendix 1 of the report titled ‘Ashhurst Domain – Scout Hall Lease Proposal’ presented to the Finance & Audit Committee on 28 April 2021.

2.   That Council, being satisfied that the functions and purposes of the Reserves Act have been considered, that the statutory processes have been met, and being satisfied that the decision is a reasonable one, exercise the authority delegated by the Minister of Conservation to grant consent for the lease at Ashhurst Domain to The Scout Association of New Zealand.

Clause 29-21 above was carried 15 votes to 0, the voting being as follows:

For:

Councillors Susan Baty, Brent Barrett, Rachel Bowen, Zulfiqar Butt, Vaughan Dennison, Renee Dingwall, Lew Findlay QSM, Patrick Handcock ONZM, Lorna Johnson, Billy Meehan, Orphée Mickalad, Karen Naylor, Bruno Petrenas, Aleisha Rutherford and Mr Stephen Armstrong.

30-21

Otira Park - Palmerston North Pony Club Branch Lease Proposal

Report, presented by Bryce Hosking, Manager - Property and Kathy Dever-Tod, Manager - Parks and Reserves.

Moved Vaughan Dennison, seconded Susan Baty.

The COMMITTEE RECOMMENDS

1.   That Council approve the lease to Palmerston North Pony Club Branch Incorporated at Otira Park, attached as Appendix 1 of the report titled ‘Otira Park – Palmerston North Pony Club Branch Lease Proposal’ presented to the Finance & Audit Committee on 28 April 2021.

2.   That Council, being satisfied that the functions and purposes of the Reserves Act have been considered, that the statutory processes have been met, and being satisfied that the decision is a reasonable one, exercise their authority to approve as delegated by the Minister of Conservation to grant consent for the lease at Otira Park to Palmerston North Pony Club Branch.

Clause 30-21 above was carried 15 votes to 0, the voting being as follows:

For:

Councillors Susan Baty, Brent Barrett, Rachel Bowen, Zulfiqar Butt, Vaughan Dennison, Renee Dingwall, Lew Findlay QSM, Patrick Handcock ONZM, Lorna Johnson, Billy Meehan, Orphée Mickalad, Karen Naylor, Bruno Petrenas, Aleisha Rutherford and Mr Stephen Armstrong.

31-21

Business Continuity Update

Memorandum, presented by Jason McDowell, Head of Risk & Resilience.

For efficiency, future business continuity updates against the review will be incorporated in the regular business assurance accountability report.

Moved Susan Baty, seconded Vaughan Dennison.

The COMMITTEE RESOLVED

1.   That the memorandum titled ‘Business Continuity Update’, presented to the Finance & Audit Committee on 28 April 2021, be received for information.

2.   That it be noted further business continuity updates against the review will be incorporated in the regular business assurance accountability report.

Clause 31-21 above was carried 15 votes to 0, the voting being as follows:

For:

Councillors Susan Baty, Brent Barrett, Rachel Bowen, Zulfiqar Butt, Vaughan Dennison, Renee Dingwall, Lew Findlay QSM, Patrick Handcock ONZM, Lorna Johnson, Billy Meehan, Orphée Mickalad, Karen Naylor, Bruno Petrenas, Aleisha Rutherford and Mr Stephen Armstrong.

32-21

Treasury Report - 9 months ending 31 March 2021

Memorandum, presented by Stuart McKinnon, Chief Financial Officer.

Moved Susan Baty, seconded Karen Naylor.

The COMMITTEE RESOLVED

1.   That the performance of Council’s treasury activity for the 9 months ending 31 March 2021 be noted.

Clause 32-21 above was carried 15 votes to 0, the voting being as follows:

For:

Councillors Susan Baty, Brent Barrett, Rachel Bowen, Zulfiqar Butt, Vaughan Dennison, Renee Dingwall, Lew Findlay QSM, Patrick Handcock ONZM, Lorna Johnson, Billy Meehan, Orphée Mickalad, Karen Naylor, Bruno Petrenas, Aleisha Rutherford and Mr Stephen Armstrong.

33-21

Quarterly Performance and Financial Report - Quarter Ending 31 March 2021

Memorandum, presented by Stuart McKinnon, Chief Financial Officer.

The Mayor (Grant Smith) entered the meeting at 9.55am.

Moved Susan Baty, seconded Karen Naylor.

The COMMITTEE RESOLVED

1.   That the memorandum entitled ‘Quarterly Performance and Financial Report - Quarter Ending 31 March 2021’ presented to the Finance & Audit Committee on 28 April 2021, be received.

Clause 33-21 above was carried 16 votes to 0, the voting being as follows:

For:

The Mayor (Grant Smith) and Councillors Susan Baty, Brent Barrett, Rachel Bowen, Zulfiqar Butt, Vaughan Dennison, Renee Dingwall, Lew Findlay QSM, Patrick Handcock ONZM, Lorna Johnson, Billy Meehan, Orphée Mickalad, Karen Naylor, Bruno Petrenas, Aleisha Rutherford and Mr Stephen Armstrong.

34-21

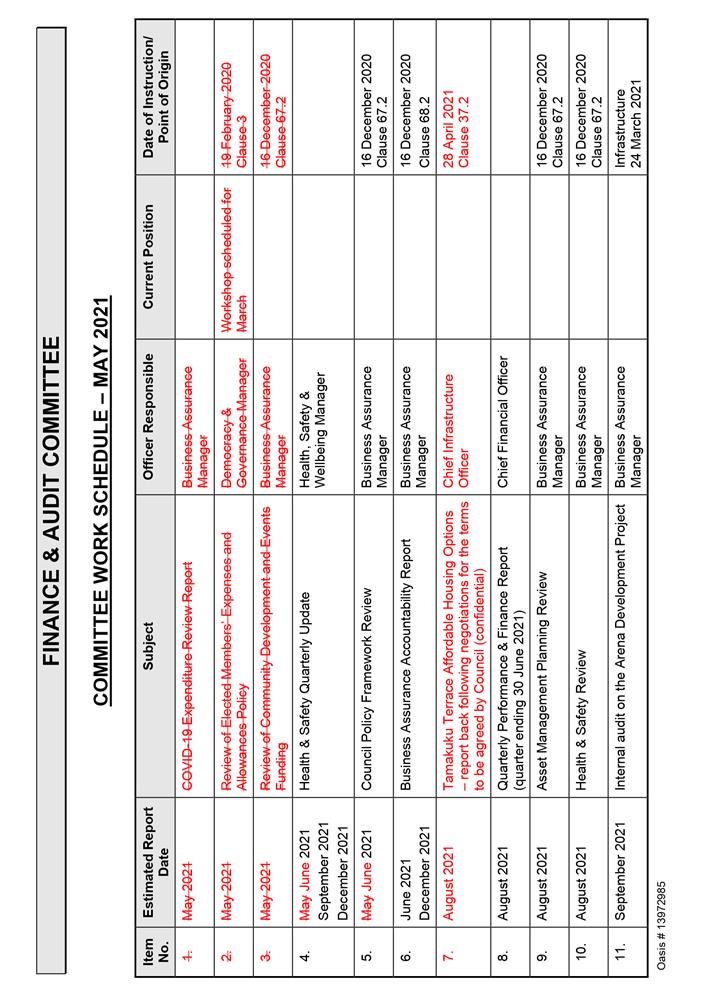

Committee Work Schedule

Moved Susan Baty, seconded Karen Naylor.

The COMMITTEE RESOLVED

1.   That the Finance & Audit Committee receive its Work Schedule dated April 2021.

Clause 34-21 above was carried 16 votes to 0, the voting being as follows:

For:

The Mayor (Grant Smith) and Councillors Susan Baty, Brent Barrett, Rachel Bowen, Zulfiqar Butt, Vaughan Dennison, Renee Dingwall, Lew Findlay QSM, Patrick Handcock ONZM, Lorna Johnson, Billy Meehan, Orphée Mickalad, Karen Naylor, Bruno Petrenas, Aleisha Rutherford and Mr Stephen Armstrong.

Exclusion of Public

35-21

Recommendation to Exclude Public

Moved Susan Baty, seconded Karen Naylor.

The COMMITTEE RESOLVED

1.   That the public be excluded from the following parts of the proceedings of this meeting listed in the table below.

      The general subject of each matter to be considered while the public is excluded, the reason for passing this resolution in relation to each matter, and the specific grounds under Section 48(1) of the Local Government Official Information and Meetings Act 1987 for the passing of this resolution are as follows:

General subject of each matter to be considered

Reason for passing this resolution in relation to each matter

Ground(s) under Section 48(1) for passing this resolution

13.

Minutes of the Finance & Audit Committee meeting - Part II Confidential - 24 March 2021

For the reasons set out in the Finance & Audit Committee minutes of 24 March 2021, held in public present.

14.

Tamakuku Terrace Expressions of Interest Response - Affordable Housing Options

Third Party Commercial and Negotiations

s7(2)(b)(ii) and s7(2)(i)

This resolution is made in reliance on Section 48(1)(a) of the Local Government Official Information and Meetings Act 1987 and the particular interest or interests protected by Section 6 or Section 7 of that Act which would be prejudiced by the holding of the whole or the relevant part of the proceedings of the meeting in public as stated in the above table.

Also that the persons listed below be permitted to remain after the public has been excluded for the reasons stated.

Clause 35-21 above was carried 16 votes to 0, the voting being as follows:

For:

The Mayor (Grant Smith) and Councillors Susan Baty, Brent Barrett, Rachel Bowen, Zulfiqar Butt, Vaughan Dennison, Renee Dingwall, Lew Findlay QSM, Patrick Handcock ONZM, Lorna Johnson, Billy Meehan, Orphée Mickalad, Karen Naylor, Bruno Petrenas, Aleisha Rutherford and Mr Stephen Armstrong.

The public part of the meeting finished at 10.17am

Confirmed 26 May 2021

Chairperson

PALMERSTON NORTH CITY COUNCIL

Memorandum

TO:                                Finance & Audit Committee

MEETING DATE:           26 May 2021

TITLE:                            Assurance Report on Review of COVID-19 Expenditure

Presented By:            Masooma Akhter, Business Assurance Manager

APPROVED BY:             David Murphy, Acting General Manager - Strategy and Planning

RECOMMENDATION(S) TO Finance & Audit Committee

1.   That the memorandum titled ‘Assurance Report on Review of COVID-19 Expenditure’ and its attachment, presented to the Finance & Audit Committee on 26 May 2021, be received for information.

1.         ISSUE

The overall objective of this review was to provide assurance over the adequacy and effectiveness of internal controls and processes put in place over expenditure incurred in relation to COVID-19. This includes response and recovery expenditure.

2.         BACKGROUND

COVID-19 has had a substantial impact on the world including our nation and city. During these unprecedented times, to ensure a successful response and recovery for the community of Palmerston North, the organisation was required to utilise a substantial amount of resources. The organisation was required to make pragmatic decisions to ensure an effective response and therefore the risk of financial control breakdown was heightened. This review presented an opportunity to assess the organisation’s expenditure that was incurred while responding to and recovering from COVID-19. This review was undertaken to capture the financial learnings and help with our ongoing journey to enhance our financial maturity, particularly under a crisis.

3.         NEXT STEPS

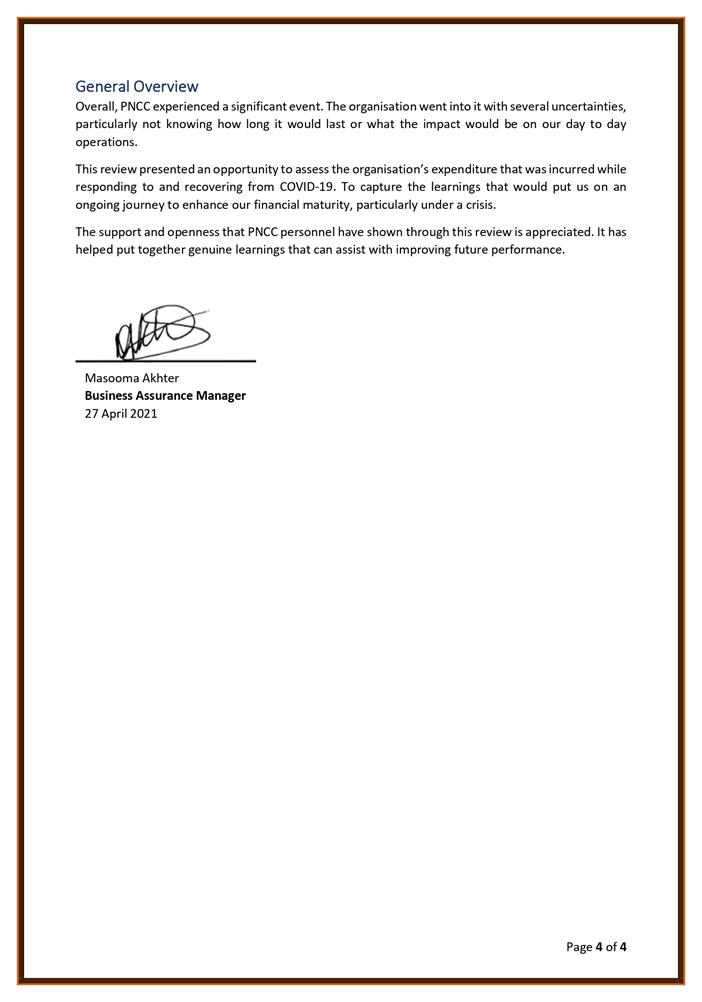

Learnings will be taken on board by ELT who will receive regular reporting on progress by Business Assurance.

4.         Compliance and administration

Does the Committee have delegated authority to decide?

Yes

Are the decisions significant?

No

If they are significant do they affect land or a body of water?

No

Can this decision only be made through a 10 Year Plan?

No

Does this decision require consultation through the Special Consultative procedure?

No

Is there funding in the current Annual Plan for these actions?

No

Are the recommendations inconsistent with any of Council’s policies or plans?

No

The recommendations contribute to Goal 5: A Driven and Enabling Council

The recommendations contribute to the outcomes of the Driven and Enabling Council Strategy

The recommendations contribute to the achievement of action/actions in Not Applicable

Contribution to strategic direction and to social, economic, environmental and cultural well-being

The purpose of this report is to report on Business Assurance activity.

Attachments

1.

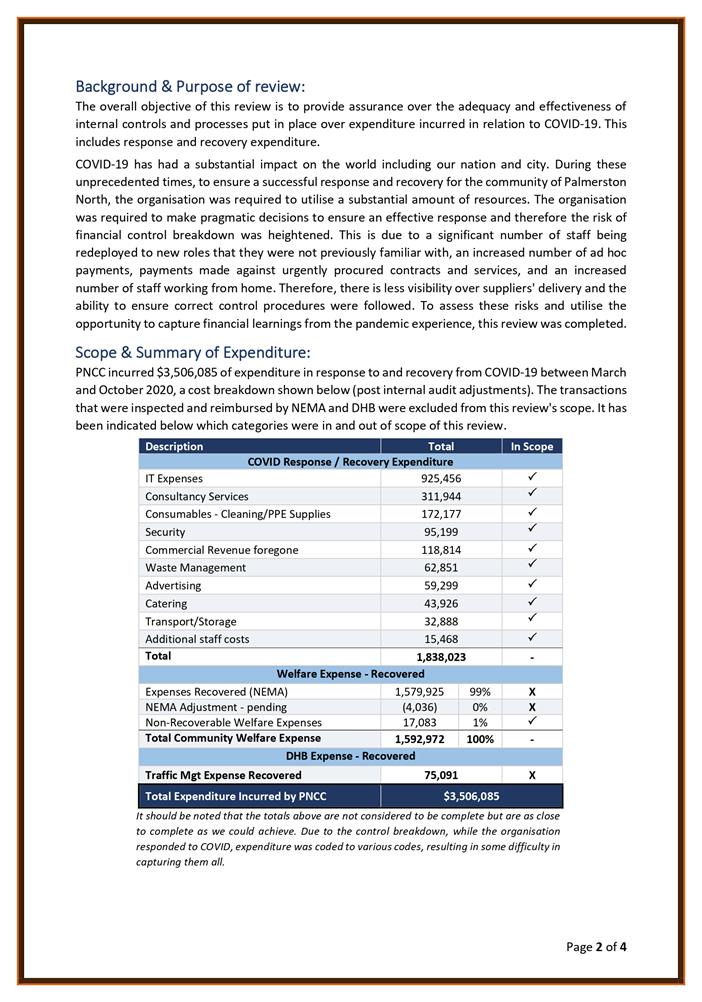

COVID Expense Review Report

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PALMERSTON NORTH CITY COUNCIL

Memorandum

TO:                                Finance & Audit Committee

MEETING DATE:           26 May 2021

TITLE:                            Assurance Report on Review of Community Grants and Events Funding

Presented By:            Masooma Akhter, Business Assurance Manager and Sheryl Bryant, Acting GM Marketing and Communications

APPROVED BY:             David Murphy, Acting General Manager - Strategy and Planning

RECOMMENDATION(S) TO Finance & Audit Committee

1.   That the memorandum titled ‘Assurance Report on Review of Community Grants and Events Funding’ and its attachment, presented to the Finance & Audit Committee on 26 May 2021, be received for information.

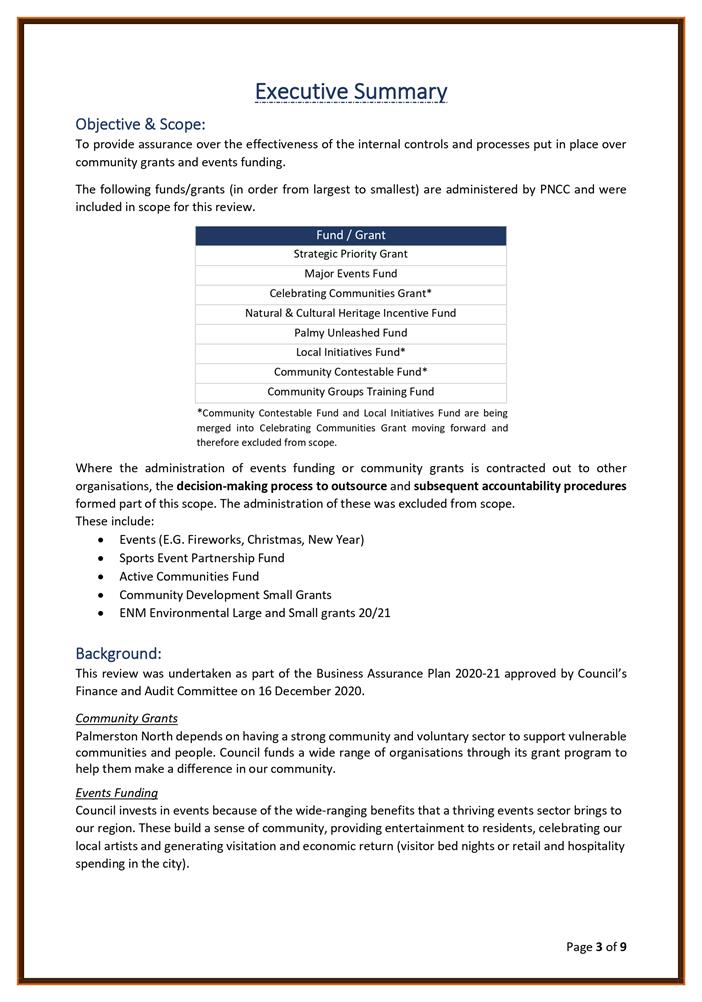

1.         ISSUE

The Business Assurance plan for 2019/20 endorsed by Council on 19 August 2019 required a review of community grants and events funding.

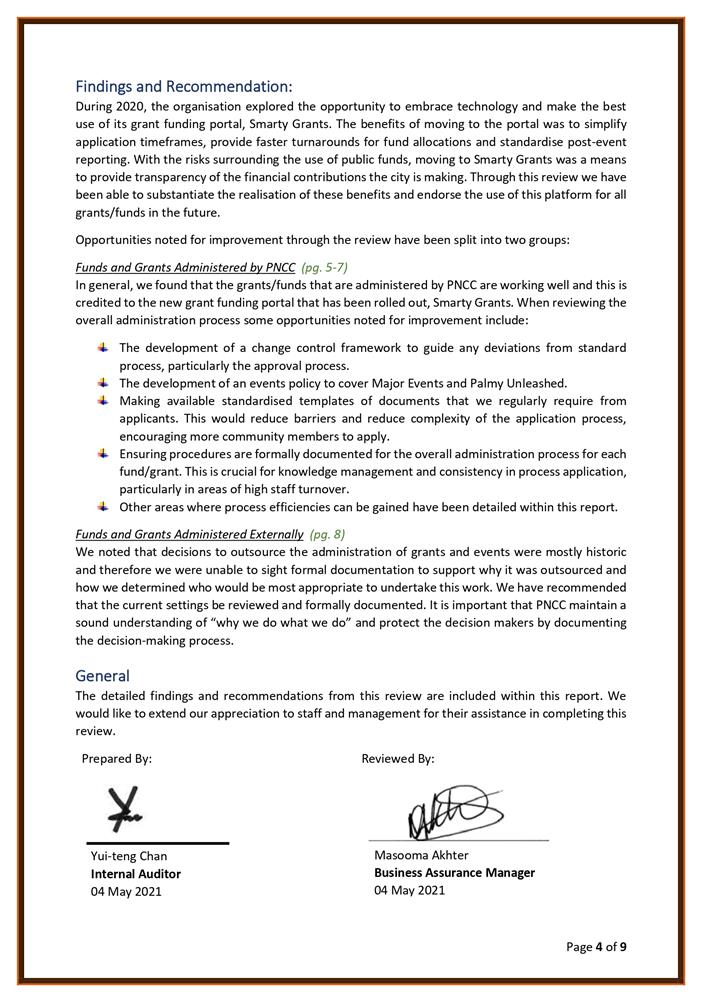

This memorandum informs the Committee of the findings and recommendations this review produced.

2.         BACKGROUND

Community Grants

Palmerston North depends on having a strong community and voluntary sector to support vulnerable communities and people. Council funds a wide range of organisations through its grant program to help them make a difference in our community.

Events Funding

Council invests in events because of the wide-ranging benefits that a thriving events sector brings to our region. These build a sense of community, providing entertainment to residents, celebrating our local artists and generating visitation and economic return (visitor bed nights or retail and hospitality spending in the city).

This review has presented an opportunity to review and provide assurance over the effectiveness of internal controls and processes put in place over community grants and events funding.

3.         NEXT STEPS

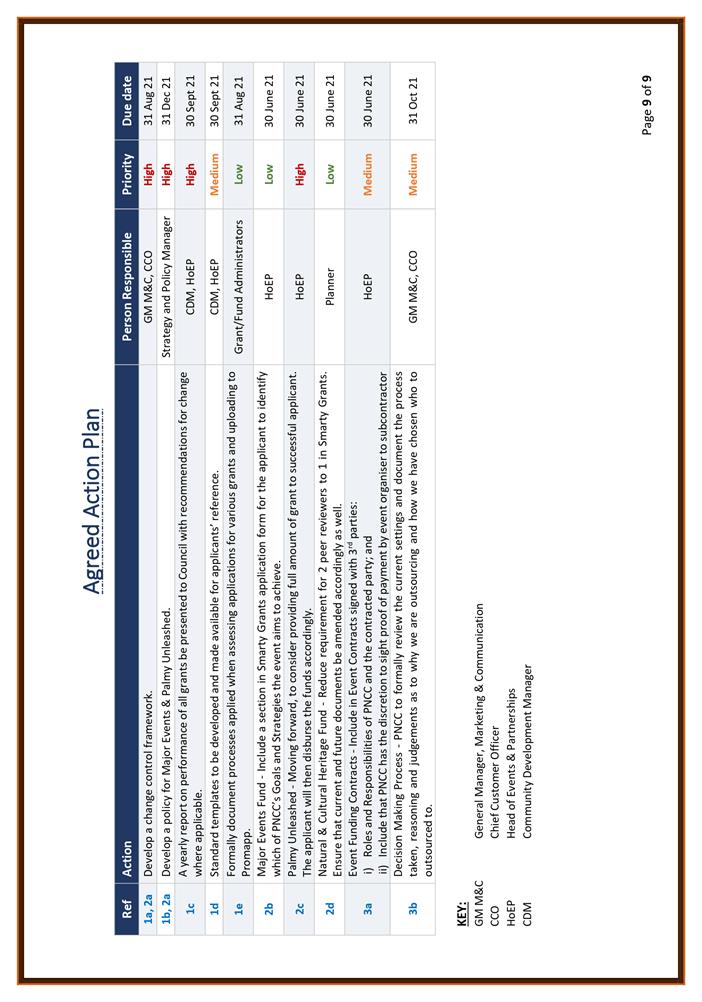

The agreed action plan will be followed up on by the Business Assurance division in due course. The results will be reported back to this Committee through the 6-monthly accountability reporting.

4.         Compliance and administration

Does the Committee have delegated authority to decide?

Yes

Are the decisions significant?

No

If they are significant do they affect land or a body of water?

No

Can this decision only be made through a 10 Year Plan?

No

Does this decision require consultation through the Special Consultative procedure?

No

Is there funding in the current Annual Plan for these actions?

Yes

Are the recommendations inconsistent with any of Council’s policies or plans?

No

The recommendations contribute to Goal 5: A Driven and Enabling Council

The recommendations contribute to the outcomes of the Driven and Enabling Council Strategy

The recommendations contribute to the achievement of action/actions in Not Applicable

Contribution to strategic direction and to social, economic, environmental and cultural well-being

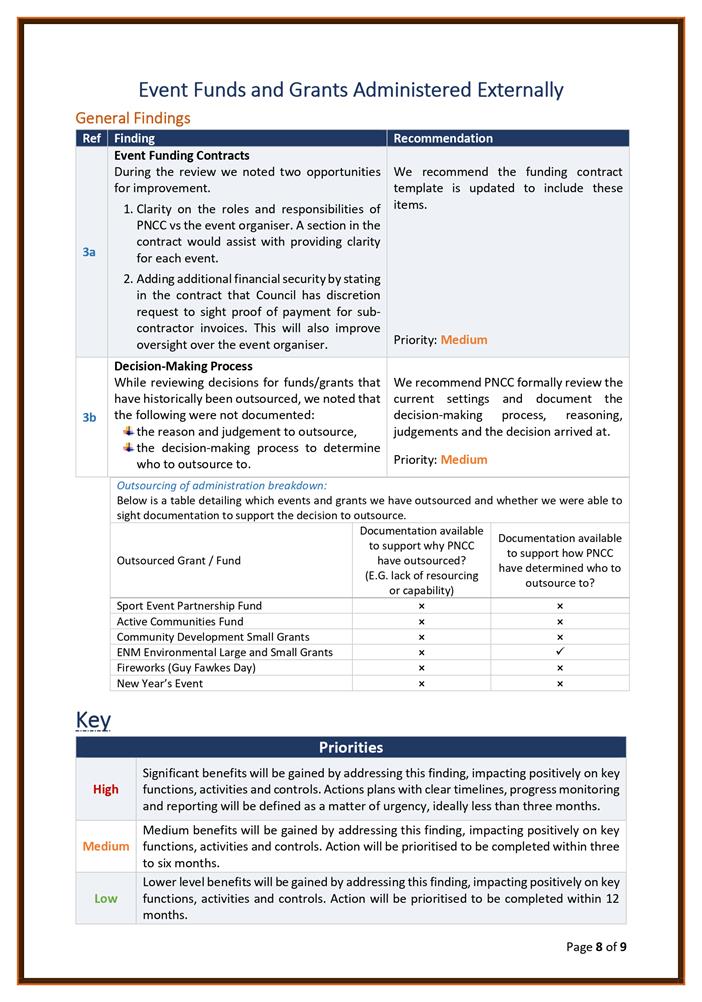

This report is presented as a business assurance activity in response to the business assurance plan endorsed by Council.

Attachments

1.

Community Grants & Events Funding Review Report

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PALMERSTON NORTH CITY COUNCIL

Memorandum

TO:                                Finance & Audit Committee

MEETING DATE:           26 May 2021

TITLE:                            Review of the Elected Members' Expenses and Allowances Policy 2021, and the Elected and Appointed Members' Professional Development & Training Policy 2021

Presented By:            Hannah White, Democracy & Governance Manager

APPROVED BY:             David Murphy, Acting General Manager - Strategy and Planning

RECOMMENDATIONS TO COUNCIL

1.   That Council approve the Elected and Appointed Members’ Expenses and Allowances Policy 2021 as attached (Attachment 1), subject to approval of the Remuneration Authority.

2.   That Council approve the Elected and Appointed Members’ Professional Development and Training Policy 2021 as attached (Attachment 2).

1.         ISSUE

1.1       In February 2020, the Finance & Audit Committee resolved:

“That a review of the Expenses Policy be undertaken to consider whether the Policy be extended to cover all appointed members, and to make recommendations for any other changes required to update the policy including to the definition of, and travel expenses associated with, Official Business, with a report to Finance & Audit Committee (in September 2020).”

1.2       In September 2020, the Finance and Audit Committee resolved that the Expenses Policy be discussed at workshop.

1.3       Officers have taken into consideration members’ points raised at a workshop held in March 2021 and revised the Elected Members’ Expenses and Allowances Policy (Expenses Policy). The reviewed, tracked changed policy is attached as Attachment 1.

2.         BACKGROUND

2.1       Council has appointed six appointed members and accorded them full voting and participation rights to sit on five Council committees in the 2019-2022 triennium. Appointed members are reimbursed for their meeting attendance but are not currently able to seek council reimbursement for training or development opportunities related to their committee roles.

2.2       In February 2020, the Finance & Audit Committee resolved to pay the expenses for an appointed member to attend a Local Government New Zealand conference. This raised the question over whether appointed members should be included in the Expenses Policy and officers were asked to review the policy.

2.3       Appointed members are expected to use their knowledge and skills to actively contribute to debate and ultimately to help strengthen council policies. By including appointed members in the Council’s Expenses Policy, Council is offering these individuals the opportunity to build their knowledge and skills base so that they might carry out their role more effectively.

2.4       The Expenses Policy sits alongside the Elected Members’ Professional Development and Training Policy (Attachment 2). As an interim measure, officers propose amending any references in the policy to ‘elected member(s)’ or ‘councillor(s)’ to ‘elected and appointed member(s)’ or ‘member(s)’. These changes will enable appointed members to be included in the policy until a full review is completed.

3.         LEGAL IMPLICATIONS

3.1       Under Schedule 7(6) of the Local Government Act 2002, “The Remuneration Authority must determine the remuneration, allowances, and expenses payable to elected members.” The Authority fixes the scale of allowances and provides guidance for what can be remunerated.

3.2       The Council’s Expenses Policy is overseen by the Remuneration Authority which regulates what elected members can claim as an expense or allowance and the amount for each.

3.3       The Remuneration Authority’s remit does not extend to appointed members. This does not prohibit the Council from including appointed members in the Expenses Policy, however appointed members’ expenses will not be scrutinised by the Remuneration Authority.

3.4       As required by the Remuneration Authority, the elected members’ remuneration determination (including the Mayor’s salary deduction for their vehicle) and hearings fees are included in the Expenses Policy and published on the Council’s website.

4.         Review of the Expenses and Allowances Policy

4.1       The Elected Members’ Expenses Policy was last agreed in November 2019 when adjustments were made to the vehicle mileage rates and Council agreed that journeys between elected members’ place of residence and the Council Administration Building would not be included in the policy.  Council also agreed not to include a childcare allowance or travel time allowance for the 2019-2022 triennium. As a recent decision, these items were not included in this review.

4.2       The review has focused on the elements directed in the resolution of February 2020, and additional changes suggested by members. Recommended changes include:

Adding Appointed Members in the Conference and Training Expenses

4.3       This will allow appointed members to attend training courses and be reimbursed for reasonable travel and attendance expenses incurred in line with the policy.

4.4       It is not envisaged to give appointed members a communication allowance as they attend a limited number of meetings annually and there are no expectations for appointed members to participate in council business outside of meeting attendance. The Council provides appointed members with a council email address, WIFI within the Council building, electronic access to the agenda, and a hard copy of the agenda where required.

Reviewing the definition of, and travel expenses associated with, Official Business

4.5       In the definitions section of the Expenses Policy council business is defined as: ‘formal council meetings, committee meetings, workshops, seminars, statutory hearings, training courses, site visits, meetings with staff, meetings with community groups, meetings with members of the public.  It does not include events where the primary focus is on social activity.’

4.6       The definition is a broad one.  Officers see no reason to change it. Elected members continue to exercise their judgement to determine the primary purpose of an event and whether or not it meets the definition of council business. The policy reserves the right of the Chief Executive to determine the appropriateness of reimbursement if an item is claimed for.

            Communication Allowance

4.7       The Remuneration Authority encourages local authorities to provide their elected members with the necessary equipment to carry out their work effectively or to remunerate them for providing their own equipment.

4.8       The Council has provided all newly elected councillors from 2019 onwards with council-owned equipment (laptop and cell phone) and proposes to extend the offer to all elected members.

4.9       Councillors that prefer to use their own cell phone and claim a phone allowance can do so under the proposed policy.

4.10     Officers recommend that Council considers a change in the policy in the new triennium so that council-owned equipment is provided to all new members in the first instance, with the expectation that eventually all members use council-owned equipment.

·    There are savings for the Council providing all elected members with council-owned equipment. Council can provide each elected member with a mobile phone for $360. Elected Members that choose to provide their own mobile phone would be eligible for $550 per year in phone allowances.

·    Council is also able to provide effective technical support to members with equipment provided by Council, as IT officers are familiar with the hardware and devices are compatible with IT infrastructure.

4.11     The Policy offers members the maximum allowance allowed by the Remuneration Authority. This will be paid to elected members with their salary.

Re-formatting

4.12     Formatting of the Policy has been undertaken in order to make it easier to follow.

Other changes

4.13     The bicycle care and public transport allowance that was included in the September 2020 draft has been removed from this version.

4.14     The following changes are recommended:

·      Making it ineligible for the vehicle mileage to be claimed for travel within the Palmerston North City Council boundary. This change would bring the policy in line with current practice.

·      Specifying that a vehicle mileage allowance may be reasonable for appointed members who live outside of Palmerston North.

·      Adding a requirement to disclose travel costs paid by outside parties on the gift register. The new requirement heightens transparency.

·      Removing the ability to claim expenses for hotel landline calls. This is no longer required as all elected members have access to a mobile phone.

·      Adding that a specified meal allowance cap to be claimed when on council business outside of the city boundary. Wording has been aligned with council staff meal allowance when travelling.

·      Including the process whereby members can apply to attend training. This inclusion is in line with the Members’ Training and Development Policy.

·     Outlining that the Mayor’s partner expenses when accompanying the Mayor on council business are covered under the Expenses Policy upon authorisation from the Chief Executive. This inclusion is in line with current delegations.

5.         FINANCIAL IMPLICATIONS

5.1       The members’ training budget has been set for 2020/21 so there is no budgetary implication for expanding the policy to include the six appointed members. The training budget will need to be shared between 21 members. Members may wish to consider how the budget is allocated in future years.

6.         NEXT STEPS

6.1       If the Committee recommends the changes, the Elected and Appointed Members’ Expenses and Allowances Policy and Elected and Appointed Members’ Professional Development and Training Policy will take effect upon Council’s approval.

6.2       Both policies will be reviewed for the next triennium.

7.         Compliance and administration

Does the Committee have delegated authority to decide?

No

Are the decisions significant?

No

If they are significant do they affect land or a body of water?

No

Can this decision only be made through a 10 Year Plan?

No

Does this decision require consultation through the Special Consultative procedure?

No

Is there funding in the current Annual Plan for these actions?

Yes

Are the recommendations inconsistent with any of Council’s policies or plans?

No

The recommendations contribute to Goal 5: A Driven and Enabling Council

The recommendations contribute to the outcomes of the Driven and Enabling Council Strategy

The recommendations contribute to the achievement of action/actions in a plan under the Driven and Enabling Council Strategy

Contribution to strategic direction and to social, economic, environmental and cultural well-being

Review of the Expenses and Allowances Policy, and associated Professional Development and Training Policy, to include appointed members ensures fairness of growth opportunities for all members which in turn contributes to effective governing of the City.

Attachments

1.

Draft Elected and Appointed Members' Expenses and Allowances Policy

2.

Draft Elected and Appointed Members' Professional Development and Training Policy

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PDF Creator

PALMERSTON NORTH CITY COUNCIL

Report

TO:                                Finance & Audit Committee

MEETING DATE:           26 May 2021

TITLE:                            Victoria Esplanade Bonsai/Shade House Project Options

PRESENTED BY:            Kathy Dever-Tod, Parks and Reserves Manager

APPROVED BY:             Sarah Sinclair, Chief Infrastructure Officer

RECOMMENDATION(S) TO Council

1.   That Council refers consideration of Option 1:  Continue with the scope as designed, and shown in Attachment One, costing $880,000, to the Ten Year Plan deliberations, noting that this will require $650,000 additional budget (Programmes 1127 and 98).

2.   That, if Council approves proceeding with the project under Option 1 during the finalisation of the Ten Year Plan, it considers funding the budget shortfall of $650,000 by seeking $150,000 in external funding and allocating an additional new capital budget of $500,000, as per Funding Option A for Option 1.

3.   That during Ten Year Plan deliberations, Council considers deferring the Bonsai/Shade house project until year two of the 2021-31 10 Year Plan, to allow 12 months for fundraising.

4.   That Council notes that if it chooses to fund the Bonsai/Shade House project by reprioritising the existing Masterplan implementation budget assumptions, the Victoria Esplanade User Group will be consulted regarding the priorities and projects that may be affected.

Summary of options analysis for

Problem or Opportunity

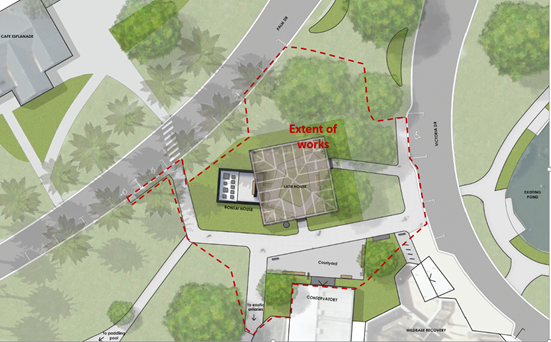

A home is required for Bonsai gifted to Council. Work to scope a Bonsai House coincided with the need to replace the Shade House which is at the end of its life. The detailed design and consenting stage of the Bonsai/Shade House project has been completed, after workshopping scope requirements with Councillors.

Aligning the project with the Victoria Esplanade Masterplan (the Masterplan), including achieving an outcome suitable for a premier park and wayfinding improvements, has resulted in the estimated cost exceeding the budget provision.

The difference between the budget and the cost estimate for the scoped project cannot be met through external fundraising, to date.

This report seeks direction on the scale and scope of the project and offers options on how to fund it.

SCOPE DECISION

Scope decision Option 1:

Continue with the project as scoped and designed, costing $880,000

Community Views

The bonsai house is a project in the 2018/28 Ten Year Plan. Nine submissions were received during the 2018/28 Ten Year Plan consultation specifically commenting on the bonsai project.  Five were in support and four opposed to the programme.

Community engagement occurred during development of the Masterplan.  This project was approved in the Masterplan.

Engagement with the Victoria Esplanade User Group is proposed prior to the finalisation of the draft 10 Year Plan.

Benefits

Implements the Masterplan:

·    Provides a quality public display for the bonsai collection currently in storage, and

·    Replaces and improves the shade house, which has reached the end of its life, and

·    Improves wayfinding and accessibility through the central area of the Victoria Esplanade.

Risks

Costs may escalate during the external fund-raising period. Mitigation is provided with an escalation allowance within the total cost estimate. Operating costs may be higher than budgeted depending on outcome.

Increases council borrowing levels.

Financial

Capital and the associated financing costs are covered in the Funding Options sections.

Operational costs of $6,000 per year have been allowed for within the draft 2021/31 Ten Year Plan.

Scope decision Option 2:

Change scope to continue with the shade house as designed, without a bonsai display, costing $700,000

Community Views

The bonsai house is a project in the 2018/28 Ten Year Plan. Nine submissions were received during the 2018/28 Ten Year Plan consultation specifically commenting on the bonsai project.  Five were in support and four opposed to the programme.

Community engagement occurred during development of the Masterplan.  This project was approved in the Masterplan.

Engagement with the Victoria Esplanade User Group is proposed prior to the finalisation of the draft 10 Year Plan

Benefits

Implements the Masterplan:

·    Replacement and improvement of the shade house which has reached the end of its life, and

·    Improves wayfinding and accessibility through the central area of the Victoria Esplanade.

Risks

Does not implement the bonsai house project of the Masterplan.

Reputational risk associated with returning/selling gifted bonsai and with supporters of the bonsai house.

Costs may escalate during the external fund-raising period. Mitigation is provided with an escalation allowance within the total cost estimate.

Increases council borrowing levels.

Financial

Capital and the associated financing costs are covered in the Funding Options sections.

Reduction of $6,000 per year in the Ten-Year Plan if bonsai are rehomed.

Scope decision Option 3:

Change scope – replace the shade house on its existing footprint, with modest bonsai house within the shade house, costing $530,000

Community Views

The bonsai house is a project in the 2018/28 Ten Year Plan. Nine submissions were received during the 10 Year Plan consultation specifically commenting on the bonsai project.  Five were in support and four opposed to the programme.

Community engagement occurred during development of the Masterplan.  This project is an element of the implementation of the Masterplan.

Engagement with the Victoria Esplanade User Group is proposed prior to the finalisation of the draft 10 Year Plan.

Benefits

Provides a low-quality bonsai house compared to Option 1.

Replaces the Shade House which is at the end of its life with some quality improvements.

Risks

Does not implement the wayfinding and accessibility improvements planned in the Masterplan.

Costs may escalate during the external fund-raising period. Mitigation is provided with an escalation allowance within the total cost estimate.

Financial

Capital and the associated financing costs are covered in the Funding Options section.

Operational costs of $6,000 per year have been allowed for within the draft 2021/31 Ten Year Plan.

Scope decision Option 4:

Change scope to replace the shade house on its footprint and to a similar quality with no bonsai house, costing $510,000

Community Views

The bonsai house is a project in the 2018/28 Ten Year Plan. Nine submissions were received during the 10 Year Plan consultation specifically commenting on the bonsai project.  Five were in support and four opposed to the programme.

Community engagement occurred during development of the Masterplan.  This project is an element of the implementation of the Masterplan.

Engagement with the Victoria Esplanade User Group is proposed prior to the finalisation of the draft 10 Year Plan.

Benefits

Replaces the shade house which is at the end of its life.

Provides accessibility improvements and taller space.

Risks

Does not implement the wayfinding and accessibility improvements planned in the Masterplan.

Does not implement the new bonsai house directed in the Masterplan. Reputational risk with supporters of the Bonsai House.

Costs may escalate during the external fund-raising period. Mitigation is provided with an escalation allowance within the total cost estimate.

Financial

Capital and the associated financing costs are covered in the Funding Options section.

Reduction of $6,000 per year in the Ten-Year Plan if bonsai are rehomed.

Scope decision Option 5:

Change scope to develop bonsai house and decommission the shade house, costing $265,000

Community Views

The Bonsai House is a project in the 2018/28 Ten Year Plan. Nine submissions were received during the 10 Year Plan consultation specifically commenting on the bonsai project.  Five were in support and four opposed to the programme.

Community engagement occurred during development of the Masterplan.  This project is an element of the implementation of the Masterplan.

Engagement with the Victoria Esplanade User Group is proposed prior to the finalisation of the draft 10 Year Plan.

Benefits

Implements the bonsai house.

Low cost option.

Risks

Does not implement the wayfinding and accessibility improvements planned in the Masterplan.

Reputational damage with current visitors to the shade house and supporters of the subtropical collection.

Substitutes one botanic display for another so no additional features are developed as directed by the Masterplan.

Financial

Capital and the associated financing costs are covered in the Funding Options section.

No new operational costs.

Scope decision Option 6:

Decommission the shade house and do not build a bonsai house, convert the area to gardens, costing $50,000

Community Views

The bonsai house is a project in the 2018/28 Ten Year Plan. Nine submissions were received during the 10 Year Plan consultation specifically commenting on the bonsai project.  Five were in support and four opposed to the programme.

Community engagement occurred during development of the Masterplan.  This project is an element of the implementation of the Masterplan.

Engagement with the Victoria Esplanade User Group is proposed prior to the finalisation of the draft 10 Year Plan.

Benefits

Lowest cost option.

Risks

Does not achieve the Masterplan objectives.

Reputational damage with current visitors to the shade house and supporters of the shade and bonsai house.

Increases the exposure of the glass panels of the conservatory to vandalism after hours.

Construction costs could exceed the cost estimate. Mitigation is provided through provision for contingencies within the total cost estimate.

Financial

Small reduction in operational costs.  Decreases renewal costs.

FUNDING DECISION

Funding for Option One:

Continue with the project as designed, costing $880,000

Total cost $880,00, less existing budget $230,000.  Shortall $650,000.

Option A:  Seek $150,000 external funding, provide a new capital budget of $500,000 - associated financing costs $25,000 per year.

Option B:  Seek $150,000 external funding, reprioritise Masterplan implementation programme 1847 and bring forward $500,000 from 2026/27 and 2027/28 and the associated financing costs $25,000 per year which had been budgeted to start from 2027/28.

Option C:  Provide a new capital budget of $650,000 with associated financing costs of $32,000 per year

Funding for Options Two:

Continue as designed but remove the bonsai house display, costing $700,000

Total cost $700,000, less existing budget $230,000.  Shortfall $470,000.

Seeking external funding is considered high risk and unrealistic.

Option A:  Reprioritise Masterplan implementation and bring forward $470,000 of funding to 2021/22 and the associated financing costs would be $24,000 per year which had been budgeted to start from 2026/27.

Option B:  Provide a new capital budget of $470,000 - associated financing costs would be $24,000 per year.

Funding for Option Three:

Change scope – replace the shade house on its existing footprint, with modest bonsai house incorporated within the shade house.

Total cost $530,000, less existing budget $120,000.  Shortfall $410,000.

Seeking external funding is considered high risk and unrealistic.

Design costs spent to date will need to be written off.

Option A:  Reprioritise Masterplan implementation and bring forward $470,000 of funding to 2021/22 and the associated financing costs would be $21,000 per year which had been budgeted to start from 2026/27.

Option B:  Provide a new capital budget of $470,000 - associated financing costs would be $21,000 per year.

Funding for Options Four and Five:

Renewals or replace shade house with bonsai house

Options 4 and 5 would be replacing an existing facility with the same or similar facility. They are therefore renewal options and are highly unlikely to attract external funding. As such there are no funding options.

The funding required for each option is as follows:

Option 4:  Shade house renewal with no bonsai – Total cost $510,000 cost, less remaining budgets of $120,000, requires additional renewal funding of $390,000.

Option 5:  Remove shade house and substitute bonsai house – Total cost $265,000, less remaining budgets of $120,000, requires additional new capital budget of $145,000.

Funding for Option Six:

Decommission the Shade House and do not display the bonsai

Total cost $50,000 for demolition, construct security gates, surface paths to entrance, provide gardens, secure front of conservatory building.

No new budget required, work covered from balance of unspent capital budget of $120,000 and the $70,000 balance declared surplus.

Rationale for the recommendations

1.         Overview of the problem or opportunity

1.1       A need for somewhere to house gift bonsai plants has been combined with the need for replacement and improvement of the current shade house which has reached the end of its functional asset life.

1.2       Detailed design and preparation of consent applications has been completed for a combined facility.  Design has been focussed to ensure that the objectives of the Victoria Esplanade Masterplan are met through the new facility.

1.3       Aligning the project with the Victoria Esplanade Masterplan, to achieve outcomes suitable for a premier park, has resulted in the estimated cost exceeding the budget provisions for both the new Bonsai House and the shade house replacement.

1.4       The difference between the budget and the cost estimate for the project cannot be met through external fundraising, therefore it is recommended that the additional funding requirement is treated as new capital expenditure.

1.5       This report seeks confirmation of the scale and scope of the project and direction on funding.

2.         Background and previous council decisions

2.1       In 2008 Council received a donation of 40 bonsai from the estate of John Birch

2.2       The bonsai have been maintained in storage, at the Council nursery, pending scoping and approval of a programme to construct a facility to display them. Figure One provides examples of the bonsai held in the nursey.

Figure One:  Bonsai examples

2.3       In 2014 a conceptual plan for a standalone bonsai house was developed. The scale was modest, with an open sided display area. It was proposed to be located where the breeding duck aviaries are currently situated.

2.4       Programme 1127 was approved in the 2015/25 Ten Year Plan with $94,000 to construct a bonsai house in 2019/20.

2.5       In 2013 an engineer assessed the condition of the shade house, the timber structure attached to the front of the Peter Black Conservatory in the mid-1980s, as shown in Figure Two.  It was assessed as being in poor condition and failing to meet current building code requirements.

Figure Two:  Shade house requiring renewal

2.6       The engineer advised that a complete rebuild was the most practical option and provided an outline estimate of $140,000 at that time.

2.7       The replacement of the shade house was budgeted for in the 2018 Ten Year Plan within Programme 98, Citywide Reserves Renewals.

2.8       In 2018 the Victoria Esplanade Masterplan (the Masterplan) was developed to give a guiding vision and direction to the park.  The Masterplan confirmed the intention to develop a bonsai house.  Within the Park Central area, the Masterplan stated:

‘develop[ing] new activity centres such as oriental gardens, bonsai house, or other garden features.’ (Page 52)

2.9       Detailed design was initiated in 2019 and involved the President of the Manawatu Bonsai Club (the Bonsai Club).  The Bonsai Club President was also engaged to work on the bonsai to bring them up to display standard and to train Council staff in their ongoing care.

2.10     The consultant designers reviewed the Masterplan and its objectives. They recommended:

·   Creating a unique identity and new activity centre for the bonsai/shade house by combining the shade house and bonsai house projects in a new facility separate from the Peter Black Conservatory,

·   Strengthening the central wayfinding spine of the park through a strong link from Central Energy Trust Wildbase Recovery/duck pond to the exotic aviaries, paddling pool, and picnic lawn space by arranging the pedestrian circulation between the buildings, and

·   Improving accessibility to the café by providing a direct route to and across the road rather than the current ‘dog-legged’ arrangement which requires those with mobility issues to move along the road rather than cross it as shown in Figure Three.

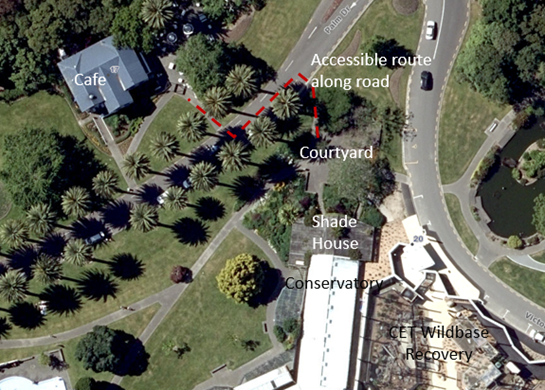

Figure Three:  Existing courtyard, paths and shade house

2.11     Figure Four shows the proposed new layout with improved wayfinding and activity centre.  The dashed red line indicates the approximate extent of the works.

Figure Four:  Concept plan showing location and extent of work

2.12     A Councillor workshop on the various Masterplan projects was held in February 2020.  During discussions on the bonsai/shade house, Councillors indicated they wished to see a large high-quality facility and were supportive of fundraising for any budget shortfall.  The feasibility of the fundraising was unknown at this point as detailed cost estimates had not been prepared.

2.13     A funding application was made to the Provincial Growth Fund for the project in July 2020. The Council was notified in September 2020 that the application had been declined.

2.14     Detailed design was completed and reviewed in late 2020/early 2021. A render of the design is provided in Attachment One.

2.15     Building consent has been applied for and consent is expected shortly.

2.16     In December 2020 a further 18 bonsai were donated from another deceased estate, taking the collection to a total of 58 trees.  The trees range in quality but under the guidance of the Bonsai Club President, the collection is developing towards the standard needed for public display.

3.         The Victoria Esplanade masterplan

3.1       The Victoria Esplanade Masterplan can be found on Councils website https://www.pncc.govt.nz/council-city/official-documents/plans/victoria-esplanade-masterplan/

3.2       ‘It is envisaged that as each project is completed, it will not only be an attraction in itself, but will also have enriched the character of the park and enhanced the enjoyment people have within it.’ (Masterplan, page 9).  The desired outcomes sought allowing flexibility, respecting the values, involving the community and using the Masterplan.

3.3       Strategic overlays for implementation include circulation, signage, planting, and architecture. These are ‘park wide considerations that will influence the development outcomes in each area’ (Masterplan, Page 19).

3.4       Circulation opportunities and considerations include reinforcing key arterial paths, developing key axis and focal points, improving visual connection for wayfinding, enhancing pedestrian connections, and aligning key paths or transition zones.

3.5       The Masterplan included 81 actions for implementation.

3.6       A list of the projects for implementation under Programme 1847 and their timing is provided in Attachment Two.

3.7       The Park Road entry to the Victoria Esplanade is planned separately under Programme 1081.  Construction is due to commence at the writing of this report.

3.8       In the Draft 2021 Ten Year Plan, the upgrade of the exotic aviaries is included within programmes 1838 and 2012, with construction planned in two stages in 2022/23 and 2027/28.

3.9       The Draft 2021 Ten Year Plan also includes Programme 1890 – Esplanade Master Plan Stage Two. This programme provides for minor adjustments to the funding provided in Programme 1847, totalling $38k over the ten years period of the Ten-Year Plan.

4.         Description of options

4.1       Options for the project are presented in two groups.  Consideration is first given to the project scope.  Following the scope, options for funding each scope option is then considered.

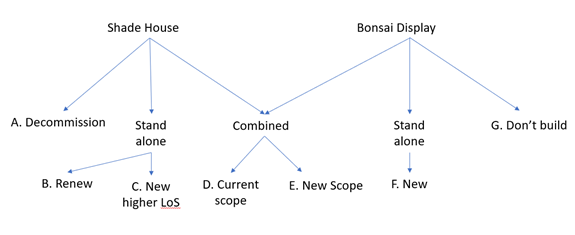

Figure Five visualises the approach taken to options.

Figure Five:  Visualisation of options

4.2       Scope Option 1:  Continue with the project as designed, with a cost of $880,000

4.3       Option One is marked D in Figure Five.  Under Option One the project would continue to the scale and scope designed, as shown in Attachment One. This is approximately $650,000 over the combined shade house and bonsai house budgets of $234,000.

4.4       The full range of benefits would be achieved, including:

·   The shade house would be repositioned to improve wayfinding in the park, allowing a coordinated hub of entrances for Central Energy Trust Wildbase Recovery, the Peter Black Conservatory and the shade/bonsai house.

·   The existing courtyard would be relocated to be positioned between the buildings, allowing for a connection to the central lawn area and improved sight lines on the main route between the playground and the paddling pool.

·   Accessibility to the café would be improved, removing the current dog leg section that requires people to traverse along the road.

·   Separating the shade house from the conservatory and combining it with the bonsai house creates a new activity centre in the Victoria Esplanade.

·   The level of service for the shade house would increase, with higher quality design, materials, accessibility, and security.

·   The bonsai house is completed to a high standard as an adjunct to the shade house, providing for the display of a new type of plant collection.

·   The cost also covers diversion of services.

4.5       There are three options for funding Option 1:

4.5.1    Option 1(A):  Seek $150,000 external funding, provide a new capital budget of $500,000

·   Council would seek external support of $150,000 for the development.  As per Section 7 officers believe this is an achievable target. A larger target would increase the risk of the funding target not being met.

·   Council provides a new capital budget of $500,000 to enable the project to proceed, without affecting other planned works in the overall Masterplan implementation programme.  The associated financing cost of the new capital is $25,000 per year.

4.5.2    Option 1(B):  Seek $150,000 external funding, reprioritise the Masterplan implementation programme 1847 and bring forward $500,000 from 2026/27 to 2027/28

4.5.3    Under Funding Option B Council would seek to stay within the overall budget set for the implementation of the Masterplan. Officers have reviewed the project list for Programme 1847 and highlighted eight projects, totalling $500K, that could be left unfunded.

4.5.4    The projects are described in Table One and highlighted within the overall workplan in Attachment Two.  These eight projects would become unfunded until such time as the Masterplan and/or Ten-Year Plan was reviewed.

Table One:  Proposed projects to cancel in order to bring funding forward

Project

Description

Victoria’s Garden (Arboretum) - $300,000

1.    Arboretum focal point/hub $100,000, (2026/27)

An architectural feature at the end of the new path.

2.    Arboretum Fitzherbert Avenue $25,000 (2026/27)

Connection of new path to Fitzherbert Avenue improved.

3.    Arboretum southern access path $145,000 (2027/28)

New main path to create one single avenue (removal of other paths).

4.    Enhance views/access to river from key points $30,000 (2027/28)

Rose Gardens - $72,500

5.    Croquet/café carpark to rose gardens access $22,500

Some minor enhancement to the entrance to make it more prominent from the car park behind the café.

6.    Rose gardens - Underground pond pump station $50,000

The Masterplan proposed undergrounding the pump.  This has not been scoped in any detail and there is some risk it will cost more than budgeted.  Feedback on the proposal notes that the current pump shed provides elevation in the gardens which is often used for taking photos.  It is also noted that underground pump stations make maintenance and access more difficult.

Play Area - $50,000

7.    Play features in play zone $200,000. Reduce by $50,000 (2026/27)

The scale of playground enhancement would be reduced by 25%.  There are no specific plans in place, with plans dependant on coordination with renewals and play opportunities and trends considered at the time.

Native Forest Area - $45,000

8.    Enhance bush/park central connection $45,000 (2027/28)

There are wayfinding and accessibility improvements planned for earlier years. These are budgeted for separately and include a level pedestrian crossing from the central area near the exotic aviaries to the native bush area.  The native forest budget of $45,000 was to consider further enhancements to the path network associated with that connection point.

Contingencies - $32,500

9.    2026/27 year – bring forward $10,000 out of $39,200

Given programmes bought forward, also bring forward a portion of the contingency allowance.

10.  2027/28 year – bring forward $22,500 out of $39,800

Given programmes bought forward, also bring forward a portion of the contingency allowance.

TOTAL - $500,000

4.5.5    The major effect of the proposed reprioritisation would be on improvements planned in the area known as the arboretum or Victoria’s Garden, shown in purple in Figure Six.

Figure Six:  Masterplan character areas

4.5.6    These are projects 1 to 4 in Table One and are shown in Figure Seven below.  These projects are interrelated and would likely be bundled as one overall design and construction project.

Figure Seven:  Projects that would be unfunded

4.5.7    Design work has not been completed for the projects proposed to be re-prioritised.  There is a risk that the costs will be higher than indicative budgets currently allow.  If Council is of a mind to set these projects aside then it will also be reducing the risk that higher costs will be added at future Asset Management Plan and 10 Year Plan revisions.

4.5.8    The financing costs associated with the $500,000 brought forward of $25,000 per year would also need to come forward, from 2026/27 to 2022/23.

4.5.9    Option 1(C):  Provide an additional new capital budget of $650,000

4.5.10  This option has the benefit of removing the risk associated with external funding.  It would also enable the project to commence sooner.

4.5.11  This funding option has no impact on other projects included in the wider Masterplan implementation.

4.5.12  Approval of a new capital budget of $650,000 could occur as part of the 2021/31 Ten Year Planning process, with an associated financing cost of $32,000 per annum.

4.6       Option 2:  Change Scope - Continue the shade house as designed, and remove the bonsai house, costing $700,000

4.7       Option Two is marked C in Figure Five.  Under this option, all the benefits of Option 1, as detailed in section 4.4, would be achieved except for the bonsai house development.

·      Council would seek to reduce the cost of the project by removing the bonsai house component, saving $180,000.

·      Council could seek to return the bonsai to the families who donated them or find another public institution that may wish to display them or sell them.

4.8       There are two options for funding scope option 2:

4.8.1    Option 2(A):  Reprioritise Masterplan implementation and bring forward $470,000 of funding

4.8.2    External fundraising is not considered realistic for this option.

4.8.3    Council would seek to stay within the overall budget set for the implementation of the Masterplan. Funding of $470,000 would be brought forward.

4.8.4    Only $30,000 of the projects listed in Table One would be funded with the remaining $470,000 unfunded until such time as the masterplan and/or Ten-Year Plan was reviewed.

4.8.5    The financing costs associated with the $470,000 brought forward of $24,000 per year would also need to come forward, from 2026/27 to 2022/23.

4.9       Option 2(B):  Provide an additional new capital budget of $470,000

4.9.1    This option has the benefit of removing the risk associated with external funding.  It would also enable the project to commence sooner.

4.9.2    This funding option has no impact on other projects included in the wider Masterplan implementation.

4.9.3    Approval of a new capital budget of $470,000 could occur as part of the 2021/31 Ten Year Planning process, with an associated financing cost of $24,000 per annum.

4.10     Option 3:  Change Scope – improve the existing shade house on its existing footprint, with modest bonsai display within the shade house, costing $530,000

4.11     Option 3 is a combination of B and C in Figure 5.

4.12     If the cost of the project as scoped is determined to outweigh the benefits, this alternate option provides the Council with the ability to display bonsai and subtropical plants at a reduced overall project cost.

4.13     This option involved rebuilding the shade house on its existing footprint which removes the cost of the external wayfinding and service relocation works.

4.14     The area allocated to the subtropical plant display would be reduced to provide space for a bonsai display area within the same shade house footprint.

4.15     Significant redesign of the project would be required to fit the new structure in with the Peter Black Conservatory.

4.16     Some improvements would be made to the shade house.  A higher roof line in parts of the building would be provided, hard surface paths to improve accessibility, and a security system for the bonsai.

4.17     The planned wayfinding and accessibility improvements to the café would not be delivered.

4.18     The quality of the bonsai display would be significantly reduced from that currently scoped.

4.19     Option 3 Funding:  Provide additional new capital funding of $410,000

4.20     The remaining unspent budget is $120,000, leaving a budget shortfall of $410,000.

4.21     The $110,000 expended to date on design would be written off as an operational expense as a new design would be required.

4.22     Option 4:  Change scope to replace the shade house on its existing footprint and quality, with no provision to display bonsai, costing $510,000

4.23     Option 4 is represented by B in Figure Five.

4.24     Option 4 is a replacement of the shade house in its current location.  The benefits and costs are the same as Option 3, but there would be no bonsai displayed enabling all the existing sub-tropical display in the current shade house to be retained.  The security system for the bonsai would not be required.

4.25     Option 4 Funding:  Provide additional renewal funding of $390,000

4.26     The remaining unspent budget is $120,000, leaving a budget shortfall of $390,000, to be funded through renewals.

4.27     The $110,000 expended to date on design would be written off as an operational expense as a new design would be required.

4.28     Option 5:  Change scope - Bonsai house only, decommission the shade house, costing $265,000

4.29     Option Five is the combination of A and F in Figure Five.

4.30     Council would reduce the overall cost by removing the shade house, the display of sub-tropical plants it houses, and building the bonsai house as an alternative facility.

4.31     The wayfinding and accessibility improvements would not be realised.

4.32     There would be a new type of plant display but no overall improvement in the number or quality of botanic displays, given one display would be substituted for another.

4.33     Redesign would be required to account for the changed location and different context of facilities to integrate with.  There is some risk around cost given no design has been completed at any level.

4.34     Option 5 Funding:  Provide additional new capital funding of $145,000

4.35     The remaining unspent budget is $120,000, leaving a budget shortfall of $145,000, to be funded through renewals.

4.36     The $110,000 expended to date on design would be written off as an operational expense as a new design would be required.

4.37     Option 6:  Decommission the shade house and do not build the bonsai house, convert area to gardens, costing $50,000

4.38     This option is a combination of A and G in Figure Five.

4.39     Council would reduce the capital, renewal and operational costs.  This is the lowest cost option.

4.40     Council would decommission the shade house and make good the front of the Peter Black Conservatory. The vacated area would be converted to a garden bed and a hard surface path added.

4.41     The bonsai house would not proceed, and the plants would be returned, rehomed or sold.

4.42     Option 6 Funding: Decommission the Shade House and do not build the Bonsai House

4.43     The indicative cost of this option is $50,000 for demolition, securing the front of the Peter Black Conservatory, establishing outdoor garden beds in place of the shade house, providing a paved path, relocating and updating signage.

4.44     The costs would be coved by existing capital budgets and a balance of approximately $78,000 would be declared surplus.

4.45     This option would result in annual savings of $6,000 of operational costs for the display of the bonsai.  The staff time for caring for the specialised sub-tropical display in the shade house would be directed to other activities in the Victoria Esplanade.

4.46     The $110,000 expended to date on design would be written off as an operational expense as a new design would be required.

5.         Analysis of options

5.1       Table Two summarises the six options, their funding options, and the associated costs, benefits and risks.

Table Two:  Summary of options

Option

Financial

Benefits

Risks

Option 1: Current scope

Funding Option A

$880,000 project cost

-  Existing budget $230,000

-  Fundraise $150,000

New capital budget in 10 Year Plan $500,000

Annual finance cost of $25,000

New operational costs of $6,000 per year

Achieves high quality sub-tropical and bonsai displays.

Achieves wayfinding improvements.

Some external funding secured, reducing borrowing.

Renews assets.

Cost escalation during the fundraising period.

Delay in the project start date is longer than expected.

The fundraising target is not achieved.

Increases Council borrowing levels.

Option 1: Current scope

Funding Option B

$880,000 project cost

-  Existing budget $230,000

-  Fundraise $150,000

Reprioritise Programme 1847 and bring forward existing budget of $500,000

Annual finance cost of $25,000

New operational costs of $6,000 per year

Achieves high quality sub-tropical and bonsai displays.

Achieves wayfinding improvements.

Some external funding secured reducing borrowing.

Stays within current funding envelope of the draft 2021 LTP.

Renews assets.

Cost escalation during the fundraising period.

Delay in the project start date is longer than expected.

The fundraising target is not achieved.

Impacts implementation of the Masterplan.

Option 1: Current scope

Funding Option C

$880,000 project cost

-  Existing budget $230,000

New capital budget in 10 Year Plan $650,000

Annual finance cost of $32,000

New operational costs of $6,000 per year

Achieves high quality sub-tropical and bonsai displays.

Achieves wayfinding improvements.

Renews assets.

Project can commence without delay.

Cost escalation during the fundraising period.

Increases Council borrowing levels.

Option 2:

Continue as designed, without bonsai house

Funding Option A

$700,000 project cost

-  Existing budget $230,000

Programme 1847 and bring forward existing budget of $470,000

Annual finance cost of $24,000

Achieves high quality sub-tropical display.

Achieves the wayfinding improvements.

Less operational costs than Option 1.

Does meet project objective for a bonsai display.

Reputational risk associated with returning/selling gifted bonsai.

Impacts other projects in the Masterplan.

Option 2:

Continue as designed, without bonsai house

Funding Option B

$700,000 project cost

-  Existing budget $230,000

New capital budget of $470,000

Annual finance cost of $24,000

Achieves high quality sub-tropical display.

Achieves the wayfinding improvements.

Less capital and operational costs than Option 1.

Does meet project objective for a bonsai display.

Reputational risk associated with returning/selling gifted bonsai.

Increases Council borrowing levels.

Option 3:

Replace shade house, modest bonsai display within shade house

$530,000 project cost

-  Existing budget $120,000

New capital budget of $410,000

Annual finance cost of $21,000

Write off $110,000 cost incurred to date to operational expense

Renews the shade house and provides a modest bonsai display.

Lower capital cost than Options 1 and 2.

Reputational risk with supporters of the bonsai house.

Increases Council borrowing levels.

Option 4:

Replace shade house, no bonsai display

$510,000 project cost

-  Existing budget $120,000

New renewals budget of $390,000

0.13% impact on rates

Write off $110,000 cost incurred to date to operational expense

Renews the Shade House with a modest Bonsai display.

Lower capital cost than Options 1-3.

Does meet project objective for a bonsai display.

Reputational risk associated with returning/selling gifted bonsai.

Increases Council borrowing levels.

Option 5:

Decommission the shade house, build a bonsai house

$265,000 project cost

-  Existing renewals budget $45,000

New capital budget of $220,000

Annual finance cost of $11,000

Write off $110,000 cost incurred to date to operational expense

Achieves high quality bonsai display.

Addresses the end of life issues associated with the current shade house.

Lower capital cost than Options 1-4.

Does meet project objective for renewing the shade house.

Reputational damage with current visitors* to the shade house and supporters of the subtropical collection.

Increases Council borrowing levels.

Option 6:

Decommission the shade house, do not build the bonsai house

$50,000 project cost

-  Existing budget $120,000

-  Capital surplus $70,000

Reduces Council’s operational, renewal and capital costs.

Addresses the end of life issues associated with the current shade house.

This is the lowest cost option.

Does not achieve the project objectives.

Does not achieve wayfinding improvements planned.

Reputational damage with current visitors to the shade house and supporters of the shade and bonsai house.

*The shade house/conservatory has approximately 60,000 visitors per annum.

5.2       A risk for all options is that the cost of carrying out the works escalates or is more expensive than estimated.  Estimates for Options 1 through 5 include allowances for escalations and contingencies.  The estimate for Option 6 includes an allowance for contingencies.

6.         Financial sumMAry

6.1       Project Costs

6.1.1    A quantity surveyor’s report (QS) for the bonsai/shade house was prepared in December 2020 with the total cost estimated at $880,000.

6.1.2    Components of the build are identified in Table Three.

Table Three:  Summary of options

Component

Total

Site preparation including demolition

 $    25,800

Services including drainage, security and irrigation

 $    54,325

Planting and garden beds

 $    27,500

Exterior paths and courtyard surfaces and car park modifications

 $    59,600

Furniture including signs, seats, fountains

 $    45,725

Structure including roof, walls, floors, doors

 $  361,425

Preliminary, general, and margins

 $    88,625

Fees including project management and consultants

 $  108,000

Regulatory fees

 $      8,000

Contingency and Escalations

 $  101,000

Total

 $  880,000

6.1.3    The total cost includes an allowance of $80,000 for contingencies and $21,000 for escalations.

6.1.4    Of the overall cost of $880,000, $110,000 has already been expended on investigations, designs, consents and project management.

6.1.5    Further expenditure of $778,000 is required to complete the project.

6.1.6    The budget provision for the replacement of the shade house and the construction of the bonsai house is $230,000.  With $110,000 spent to date, the amount of remaining budget available is $120,000.

6.2       There is a $650,000 funding gap to complete the project as currently designed.

6.2.1    There is little opportunity to further value engineer the design to reduce costs.  During the detailed design development, the following value engineering decisions to constrain costs were made:

·    Reducing the area of hard surfaces initially proposed by the design consultant

·    Limiting the scope to exclude the level crossing to the café which was initially proposed in the package from the design consultant

·    Limiting the number of seats in the courtyard area

·    Requesting a modest wind lobby/entry to the Peter Black Conservatory which is exposed by the relocation of the shade house

·    Recycling some existing pavers

6.2.2    The project team have identified further potential savings in the order of $20,000 to $40,000. These savings would result in a reduction in the quality/benefits of the project, for example, if the drinking fountain is excluded from the project.  It is not recommended that these potential savings be pursued.

6.3       Components of the total cost

6.3.1    There are three components integrated into the one project:

Shade house replacement*                                       52%     $462,000

Bonsai house*                                                             26%     $228,000

External works for wayfinding and accessibility*#     22%     $190,000

Total cost                                                                    100%   $880,000

* Fees and generic costs have been proportioned across the project component costs

# paths, courtyard between the buildings, landscaping, drinking fountain

7.         External Fundraising and timing assumptions

7.1       Council discussion during the workshop in February 2020 indicated a desire to have a larger bonsai display and pursue external fundraising.

7.2       At this time the concept plans had been costed at $630,000.  The exclusions in the cost estimate, including project management and contingencies, meant the total likely outturn cost at this time was at least 20% more.  The concept design was still being worked on and value engineering options were to be considered.

7.3       An application was made to the Provincial Growth Fund but was unsuccessful.

7.4       Recent Council projects that have set fundraising objectives have proved difficult to achieve.

7.5       The Funding Specialist and Relationships Manager does not consider it realistic for the Council to fundraise the $650,000 unsecured funds needed to complete the project, which represents 74% of the total project cost.

7.6       Large funders often require a minimum 1/3rd of the project funding to be in place before an application will be accepted.  A further $64,000 of council funding would be required to fund 1/3rd of the project cost.

7.7       Historically projects where 1/3rd of the Council funding is in place have been supported by a major community-led fundraising effort to raise 1/3rd of the cost, which has then supported major grant funding applications for the final 1/3rd

7.8       The bonsai/shade house project has numerous supporters associated with the Victoria Esplanade, but they do not have the capacity or means to undertake a substantial fundraising campaign.

7.9       Council’s Funding Specialist and Relationships Manager suggests that a realistic target for fundraising is $150,000. He notes:

-     There may be the opportunity for some private sector sponsorship and donations.

-     There is an opportunity to seek support from Lotteries in the 2nd round of the Community Facilities Fund.

-     Funding at the $150,000 level could be secured through a range of smaller scale funders, and not rely solely on a large contribution from a single funder like Lotteries.

7.10     Securing external funds for the project will take twelve months, delaying construction until Year Two of the 2021/31 Ten Year Plan.

7.11     The bonsai/shade house project cannot be completed in the 2020/21 financial year as planned.

8.         Conclusion

8.1       Council has sought to provide a high-quality facility for the display of bonsai for the collection currently in storage at the Council nursery and a quality replacement for the current shade house which has reached the end of its life.

8.2       The Victoria Esplanade Masterplan has lifted the community expectations of the quality of new and replaced features.  The Masterplan also has a focus on improving wayfinding through the park and supporting pedestrians and accessibility.

8.3       The budget allowances for implementing a programme of works to redevelop the Esplanade was made in 2015. This was before the Masterplan was developed, levels of service were determined, and designs completed. The cost of achieving the objectives and benefits contained within the Masterplan are higher than the current budget provision.

8.4       Council’s Funding Specialist and Relationships Manager advises that $150,000 is an achievable fundraising target. This is well short of the level of external funding required to complete the Bonsai/Shade House with the current scope and budget. Therefore, officer recommendation is that the project is considered as new capital, to enable work to continue on delivering the assets.

8.5       The project scope aligns well with the objectives and benefits contained within the Masterplan. The design has been developed over many months in conjunction with stakeholders and has been value engineered to minimise project costs without impacting on benefits. It is recommended that Council consider either this option, or a lower cost outcome which achieves the housing of both bonsai and shade plants, but that doesn’t meet the wider aspirations of the Victoria Esplanade Masterplan.

8.6       It is recommended that Council determine the proposed scope it wishes to pursue as part of its deliberations on the 2021/31 Ten Year Plan and pursues $150,000 of external funding.

9.         Next actions

9.1       Consider funding options for the bonsai/shade house as part of the deliberations on the 2021-31 Ten Year Plan.

10.       Outline of community engagement process

10.1     The bonsai house was a project in the 2018-28 Ten Year Plan. Nine submissions were received specifically commenting on the bonsai project.  Five were in support and four opposed the programme.

10.2     Community engagement occurred during the development of the Victoria Esplanade Masterplan.  The bonsai/shade house project is an element of implementing that plan.

10.3     The design of the bonsai/shade house included consultation with the Manawatu Bonsai Club and engagement with the Victoria Esplanade User Group.

10.4     The Victoria Esplanade User Group have been advised that the project was being reported back to Council due to cost and funding issues.  They have not been consulted on the possible reprioritisation of the Victoria Esplanade Masterplan projects or the options to only renew or decommission the shade house. Consultation with the User Group can be carried out if Council chooses to fund the project by reprioritising the existing Masterplan implementation budgets.

Compliance and administration

Does the Committee have delegated authority to decide?

No

Are the decisions significant?

No

If they are significant do they affect land or a body of water?

No

Can this decision only be made through a 10 Year Plan?

No

Does this decision require consultation through the Special Consultative procedure?

No

Is there funding in the current Annual Plan for these actions?

No

Are the recommendations inconsistent with any of Council’s policies or plans?

No

The recommendations contribute to Goal 2: A Creative and Exciting City

The recommendations contribute to the outcomes of the Creative and Liveable Strategy

The recommendations contribute to the achievement of action/actions in the Active Community Plan

The action is: Implement projects from approved Master Plans, Reserve Management Plans and Development Plans (Page 10)

Contribution to strategic direction and to social, economic, environmental and cultural well-being

The bonsai/shade house development was contemplated and approved in the Victoria Esplanade Masterplan. It provides a unique visitor designation and horticultural display experience.  The project also improves accessibility and wayfinding within the Victoria Esplanade.

Attachments

1.

Bonsai and Shade House Design Render

2.

Masterplan Work Plan

PDF Creator

PDF Creator

PALMERSTON NORTH CITY COUNCIL

Committee Work Schedule

TO:                                Finance & Audit Committee

MEETING DATE:           26 May 2021

TITLE:                            Committee Work Schedule

RECOMMENDATION(S) TO Finance & Audit Committee

1.   That the Finance & Audit Committee receive its Work Schedule dated May 2021.

Attachments

1.

Committee Work Schedule_May 2021

PDF Creator

PDF Creator

PDF Creator
