TO: Planning & Strategy Committee
MEETING DATE: 11 May 2022
TITLE: Options for Road Closure

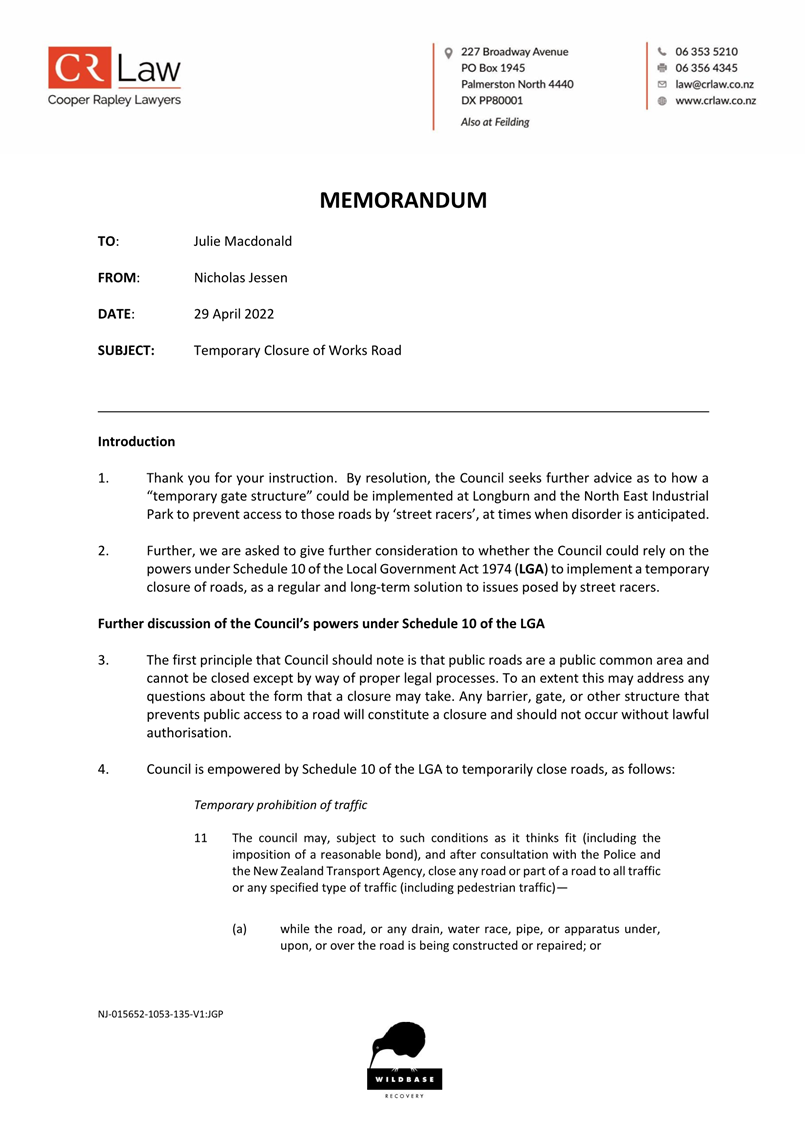

Presented By: Julie Macdonald, Strategy & Policy Manager and Chris Lai, Senior Transportation Engineer
APPROVED BY: David Murphy, Chief Planning Officer
Sarah Sinclair, Chief Infrastructure Officer
RECOMMENDATION TO Planning & Strategy Committee
1. That the Committee receive the memorandum titled ‘Options for Road Closure’ dated 11 May 2022.
1. ISSUE
In March 2022 the Planning and Strategy Committee considered the report titled ‘Options to address ’street racer’ issues. Among other decisions, the Committee resolved:
That the Chief Executive provide an update on engineering and legal solutions to the Planning and Strategy Committee in May 2022.
That option 4 is explored fully, engaging a specific piece of work, asking the Chief Executive and officers to explore how a ‘temporary gate structure’ can work on Longburn and North East Industrial Parks.
This memorandum is in response to these resolutions.
2. BACKGROUND
In March 2022 officers provided a report to the Planning and Strategy Committee in response to a resolution in October 2021:
That the Chief Executive investigate the anti-social and ‘street racer’ activity occurring at various locations on the outskirts of Palmerston North and provide advice on the various options Council could pursue to address this problem.
The report provided an analysis against criteria of each of the identified options and made recommendations to Committee and Council about future actions to help address the problem. The options were:
Option 1: Limit access to Works Road through a bylaw
Option 2: Develop a ‘Cruising Bylaw’
Option 3: Make Works Road a ‘No Parking’ area
Option 4: Temporarily close Works Road
Option 5: Permanently close Works Road
Option 6a: Physical deterrent (installation of speed humps)
Option 6b: Physical deterrent (surface treatment)
Council adopted the recommendations of the report, to proceed with options 1 and 3, and 6a. Work is underway to implement those options.
At the Planning and Strategy Committee there was discussion about the report recommendation that temporary road closure (option 4) would not be an effective response to the identified problem. Following this discussion, the Committee resolved to further investigate option 4, the temporary closure of Works Road and North East Industrial Parks, and, to consider the viability of gates at those locations. The Committee also resolved to receive an update on engineering and legal solutions.
3. discussion
Engineering update
Staff continue to monitor emerging roading treatments. Speed humps have been installed at both Works Road and El Prado Drive and staff are in the process of implementing the parking restrictions described in the earlier report. Staff continue to liaise with other councils to share ideas and information about effective responses to street racers.
Temporary road closure using gates

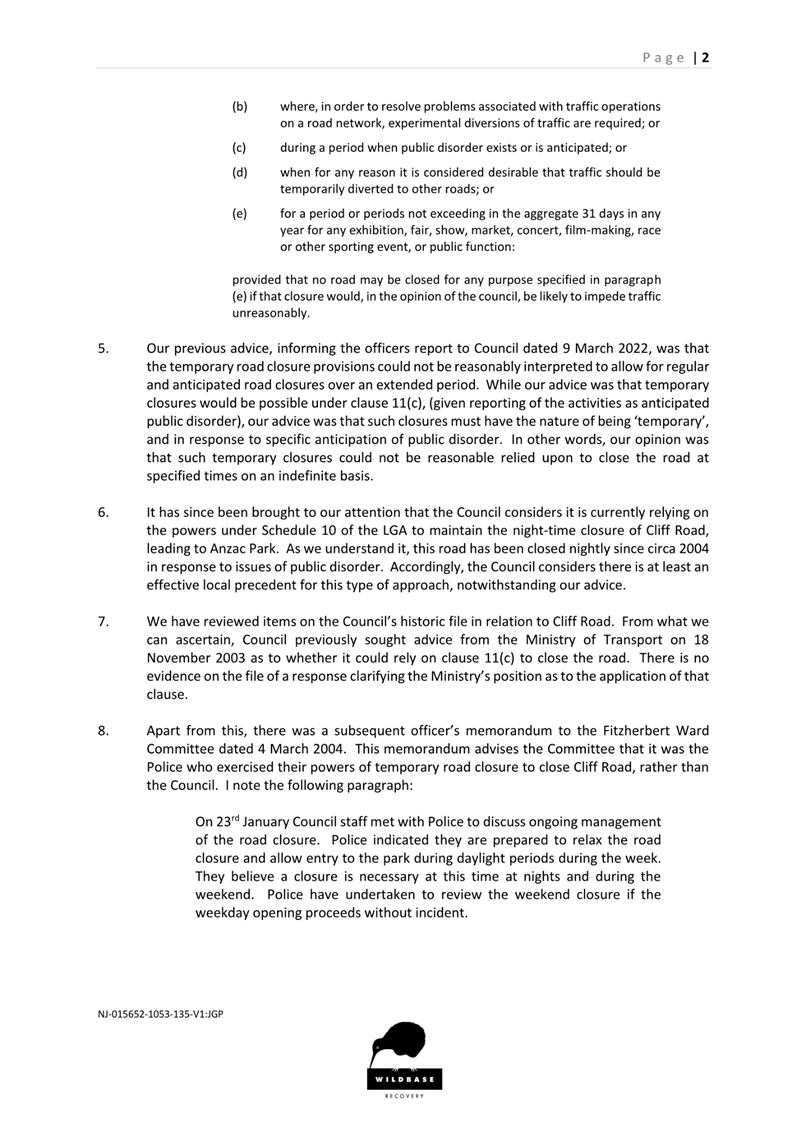

The Committee has requested further information about the use of ‘temporary gate structures’ to close Works Road and/or the North East Industrial Park. In the March report to Committee the various options were evaluated against these criteria:
a. Legal -whether the option can be implemented under law
b. Viable – whether the option can be practicably implemented
c. Effective – whether the option will work
d. Enduring – how long the option will last
e. Applicable to other locations
f. Timely – how quickly the option can be implemented
g. Avoids other adverse effects
This report expands on the advice already received to consider the legal and practical issues of achieving temporary road closure through the use of gates.

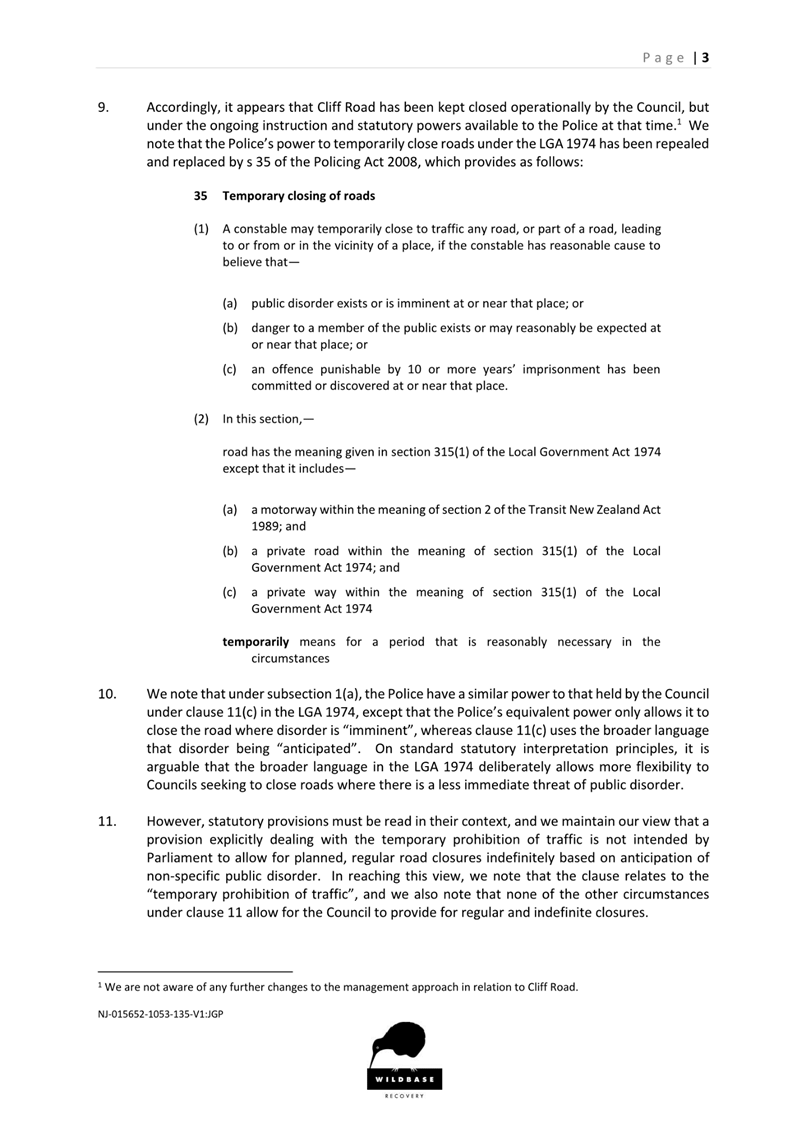

Legal advice
This section of the report considers the legal issues involved in installing gates to control access to Works Road and El Prado Drive. CRLaw has provided advice on this matter, which is appended as attachment 1. The legal advice notes that temporary road closure has merit it is unlikely to be legally reliable as a permanent solution to the identified problem. The advice suggests that if any temporary road closure is made, that this should be for a defined period until such time as the anticipation of public disorder abates.
Viability
This section of the report considers the practical issues involved in installing gates to control access to either site. This would be achieved through some type of pin-entry mechanism (for example, through an app or a key-pad, or with a swipe card or fob at the entry point). The installation of gates at either location poses several challenges:
- Whatever mechanism was installed would require ongoing Council support to manage access, including on-call response for fire and emergency and contact from legitimate users unable to gain access. Unlike some locations (such as Otene Road in Hastings) with a limited number of residential properties on a closed road, each of the industrial park sites has many vehicle movements by multiple parties. Maintenance of a secure pin system or the provision of cards/ fobs would require ongoing Council support. In general, the greater the number of people with access to the gate, the less secure the gate will be, due to the increasing likelihood of access codes being shared.
- The cost of installing gates would likely be in excess of $50,000 per location plus the cost of the technology to enable access and ongoing operational costs. Staff note that other mechanisms, such as bollards, would be a much greater cost.
- Because these sites are public roads, the control of any gate mechanism cannot be handed over to private parties. Some instances which have been cited as analogous to the Palmerston North sites (such as Tidal Road in Auckland) are private roads, where the property owners can manage their own access. As the road controlling authority, the Council cannot delegate responsibility and so would need to remain responsible for managing access. This would potentially be a 24-hour availability response, and so would incur staffing and out-of-hours costs.
- Any gate structure would need an appropriate turning area which would cost in excess of $100,000 per site and may require additional land to be purchased from adjacent properties. There may also be a requirement for fencing of adjacent properties. This provision would be to enable the safe exit for any vehicles failing to gain access to the closed road.
- Similarly, consideration would need to be given to managing any queued traffic waiting to gain access through a gate, which may require changes in road layout.

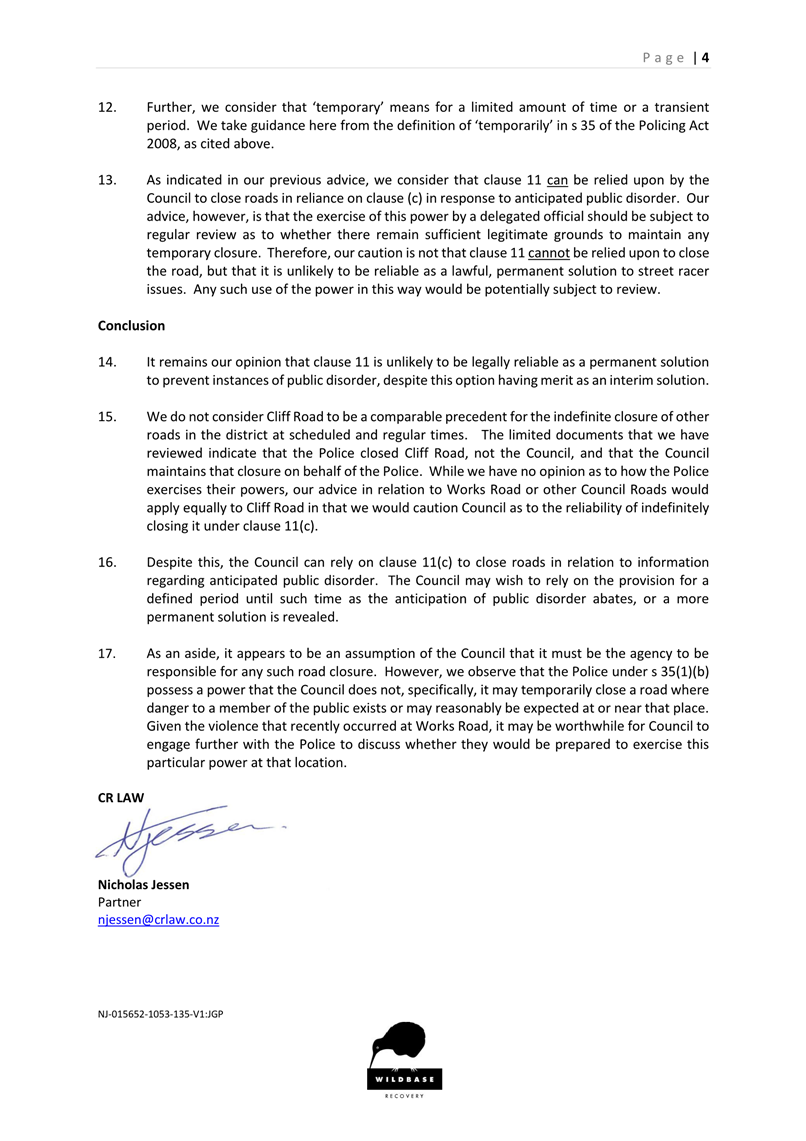

- While the objective may be for temporary road closure (see the legal issues, above) the mechanisms required to achieve road closure are essentially of a permanent nature.
Summary
The Committee requested advice about how a temporary gate structure could work at the two locations under discussion. Staff consider that the installation of gates is not a viable solution to the problem due to the significant cost, resourcing implications and other challenges to achieving safe and effective access to the site/s while gates are in place.
Officers also note that the scheduled regular closures on an indefinite basis is not likely to be legally reliable as a permanent solution to the problem identified. In addition to the considerable logistic issues in achieving road closure through the installation of gates, the other problems identified in the March report remain. For example, street racer activity may be diverted to other, potentially residential, locations.
4. NEXT STEPS
This memo is for information only. If the recommendation is received then there will be no further actions, other than those previously agreed as outcomes of the earlier report (in March 2022).
5. Compliance and administration
|
Does the Committee have delegated authority to decide? If Yes quote relevant clause(s) from Delegations Manual |
Yes |
|
|
Are the decisions significant? |
No |
|
|
If they are significant do they affect land or a body of water? |
No |
|
|
Can this decision only be made through a 10 Year Plan? |
No |
|
|
Does this decision require consultation through the Special Consultative procedure? |
No |
|
|
Is there funding in the current Annual Plan for these actions? |
Yes |
|
|
Are the recommendations inconsistent with any of Council’s policies or plans? |
No |
|
|
The recommendations contribute to Goal 1: An Innovative and Growing City |
||
|
The recommendations contribute to the achievement of action/actions in Transport The action is: Develop, maintain, operate and renew the transport network to deliver on the Council goals, the purpose of this plan, and the Government Policy Statement on Transport. |
||
|
Contribution to strategic direction and to social, economic, environmental and cultural well-being |
Council’s continued attention to street racing and may contribute to the effective and safe operation of the city’s transport network.
|
|
|
1. |
Legal advice ⇩ |
|
TO: Planning & Strategy Committee
MEETING DATE: 11 May 2022
TITLE: Committee Work Schedule
RECOMMENDATION(S) TO Planning & Strategy Committee
1. That the Planning & Strategy Committee receive its Work Schedule dated May 2022.
|
COMMITTEE WORK SCHEDULE MAY 2022 |
||||
|
Estimated Report Date |
Subject |
Officer Responsible |
Current Position |
Date of Instruction and |
|
|
|
|
||
|
8 June 2022 |
Process and options, including the use of bylaws, to establish and enforce heavy vehicle routes in the city’s urban transport network. |
Chief Planning Officer |
||
|
8 June 2022 |
Palmerston North Civic and Cultural Precinct Masterplan – Update Report |
Chief Planning Officer |
Project setup |
|
|
10 August 2022 |
Investigate options for free bus fares for priority groups |
Chief Infrastructure Officer/Chief Planning |
Collaborating with Horizons Regional Council |
|
|
14 September 2022 |
Draft Procurement Policy targeting social and |
Chief Planning Officer |
Procurement audit currently in progress. Policy delayed until audit completed and recommendations endorsed. |
|
|
14 September 2022 |
Information relating to the description, timing and quantum of the infrastructure work programmes to enable growth in Aokautere. |
Chief Planning Officer |
||
|
New triennium |
Palmerston North Civic and Cultural Precinct Masterplan – Final Report |
Chief Planning Officer |
||
|
New triennium |
Licensing, Regulatory and Service Provision Tools for Waste Minimisation, and Impact Council Service Provision has on Commercial Sector |
Chief Infrastructure Officer/Chief Planning |
||
|
New triennium |
Draft Waste Management and Minimisation Bylaw – Approval for Consultation |
Chief Planning Officer |
||
|
New triennium |
Initiate a process to extend parking restrictions to
other |
Chief Planning Officer |
||
|
TBC |
Street racer issue - Explore how a ‘temporary
gate |
Chief Infrastructure Officer |
||
|
TBC |
Ferguson/Pitt Street Intersection Upgrade - additional safety management options and timings |
Chief Infrastructure Officer |
Council 2
March 2022 |
|

TO: Planning & Strategy Committee
MEETING DATE: 11 May 2022
TITLE: Wastewater Discharge Consent Project - Progress Update
Presented By: Mike Monaghan, Group Manager - 3 Waters
APPROVED BY: Sarah Sinclair, Chief Infrastructure Officer
RECOMMENDATION TO Planning & Strategy Committee
1. That the Committee note the progress update on the Wastewater Discharge Consent project.
1. Background
1.1 Council formally adopted the preferred Best Practicable Option (BPO) for the future management of the city’s wastewater at the Extraordinary Meeting of Council held on 15 September 2021. An Adaptive Management approach was adopted as part of this resolution which enables an enduring focus on limiting the amount of highly treated wastewater that is discharged to both land and river, by finding beneficial other uses and by reducing the amount of wastewater generated by the City.
1.2 Following the endorsement of the BPO the Project Team are progressing a ‘consentable solution’. The PNCC Wastewater Treatment Plant (WWTP) discharge remains authorised by the current discharge consent until 2028. This provides time to seek a new discharge consent and construct the consented solution.
1.3 This phase of the project is now known as the ‘Wastewater Discharge Consent Programme’ (WDCP).
The WDCP will develop and determine -
· Concept Design of the wastewater treatment plant sufficient to satisfy the information requirements of the resource consent application
· Assess the effects of the BPO for land and river discharges
· Specific mitigation to be included in the application for new consents.

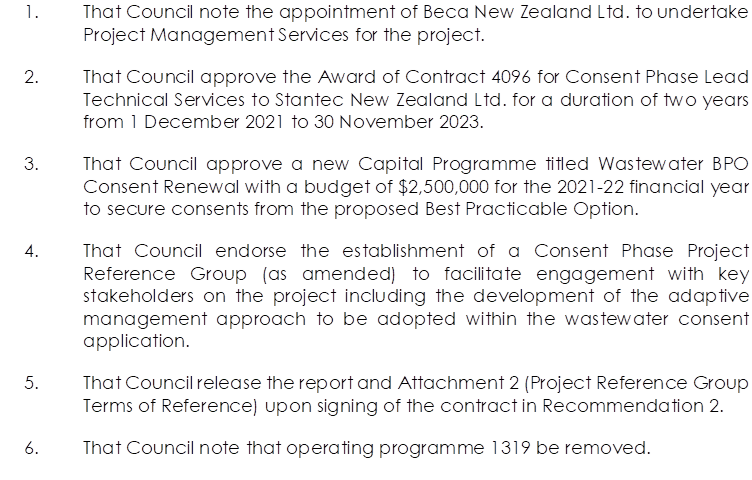

1.4 In December 2021 Council endorsed the recommendations for the Consenting Phase Implementation. These included:

2. Update on Project Progress
Technical Workstreams
2.1 Following the engagement of the lead designer Stantec (supported by PDP consultancy), supporting specialists have been engaged including Aqualink (reviewers for the irrigation workstream), Aquanet (river monitoring and modelling), Simpson Grierson (legal advisor), The Property Group and others including iwi and hapu advisors.
2.2 The workstreams that are being undertaken for this stage of consenting are:
|
Task |
What are we trying to determine |
|
Land application areas investigation |
To demonstrate that there are suitable sites for the irrigation of the highly treated wastewater |
|
Wastewater flows and loads |
To develop future projections of the amount of wastewater and the contaminant loads for the next 50 years, to ensure that the design of the treatment is suitable for future changes in population and water usage. |
|
River modelling |
Modelling of the river water quality and ecology, as a baseline of current day, and with future projections of the highly treated in-river discharges to confirm wastewater treatment levels to meet regulatory requirements |
|
Wastewater treatment plant concept design |
Further development of the treatment concept, including changes to layout of the existing plant to add new processes to meet required treatment standards |
|
Treated wastewater pipeline concepts |
Work to determine options for the location of the wastewater pipelines required to convey the treated wastewater from the plant to the land application areas |
|
Effects investigations – River discharge |
Investigations required for the assessment of effects for the resource consent applications. These include · Public health risk assessment · Water quality and ecology · Recreation · Water supply protection |
|
Effects investigations - Land |
Investigations required for the assessment of effects for the resource consent applications. These include · Public health risk assessment · Terrestrial ecology · Water supply protection · Groundwater quality · Sensitives land uses · Social and economic · Archaeological |
|
Cultural values assessment |
This assessment is prepared by tangata whenua and assesses the effects of the wastewater scheme on such matters as the river, mauri, sites of significance, mahinga kai, kaitiakitanga |
2.3 These workstreams will lead to the development of the consent application documents, and the assessment of effects on which the consents are based.
Technical Workstreams Updates
Land Application workstream
2.4 Identification of land for testing its suitability for irrigation is a high priority. An advisory group has been established with PDP, The Property Group, Federated Farmers and Food and Fibre.
2.5 The Project Team have identified a larger land area to focus further investigations within. This area has been identified through an assessment process, with larger land parcels being preferred to maximise the available area to discharge wastewater per property.
2.6 The Project Team are aware of concern in the farming community about identification of land for the irrigation. Discussions with Food & Fibre and Federated Farmers have highlighted this matter on several occasions.
2.8 At the end of April contact has been made with several landowners to seek permission to undertake soil investigations. The soil investigations are required to inform the Land Application workstream.
2.9 A media release and a letter drop to properties with the spatial area identified for investigations occurred in early May. The letter drop included approximately 600 properties and the letter provided a project update to these property owners.
2.10 Communications regarding the soil investigation elaborate that the testing proposed does not pre-determine those land parcels are being required for the discharge of wastewater for the project. These investigations are required to collect information within a geographical area.
Data Gathering and Monitoring workstream
2.11 Data continues to be collected for the monitoring regime required as baseline information to inform the consent application. Ecological information is being collected from the Manawatū River to provide baseline data to be used for the freshwater assessments of impact of the discharge.
2.12 Officers continue to seek advice from iwi partners and other experts on the monitoring required at this consent stage.
Design Workstreams
2.13 The Flows and Loads Workstream has been progressed near to completion. This comprises assessments of inputs into the plant over the next 50 years, including trade waste, and is assumption based. There have been some discussions with significant trade waste producers, which will continue through the consenting process, to ensure any planned future changes in trade waste at this stage are included in our assumptions.
2.14 The Flows and Loads workstream also includes assumptions about discharges from the plant. Work continues on adaptive management, utilising the skills and experience of the project reference group – at this stage broad assumptions have been made about the levels of flow to be discharged, to enable the remaining design work to progress.
2.15 The Concept Design workstream for the Wastewater Treatment Plant has been scoped and agreed with Stantec.
2.16 The BPO process selected Treatment Level 4 (TL4) for the Project. However, at that time design concepts had not resolved whether there would be a different level of treatment for the land discharge, to preserve more nutrient in the treated water. At current concept design stage, consideration has been given by the design team to what this would entail in practice – likely two different treatment trains for at least part of the treatment process. This has cost and operational implications.
2.17 Consideration is also being given to the consequential operating costs of cut and carry farm management potentially requiring added nutrient if the water is treated to a TL4 level, whilst noting that adaptive uses of treated water will be significantly greater if the water is produced without nutrient.
2.18 Treatment scenarios have been integral in discussions with Rangitāne in recent months, with Rangitāne indicating a preference for TL4 100% of the time.
2.19 Work on a strategy for biosolids has commenced – at present biosolids from the treatment plant are composted and used at the closed landfill at Awapuni. Future scenarios indicate that more biosolid will be produced with the new treatment regime, and the use of biosolids to create the closed landfill capping layer will not be required for the whole consent period. Therefore, other disposal options have to be identified and costed.
Consent Preparation
2.20 A Draft Consent Strategy has also been prepared by Stantec and is being worked through with the wider project team. The Consent Strategy is an important milestone to outline the statutory approvals and consenting pathway for the Project, and strongly influences the workstreams and the programme for completion of the consent application.
Project Partner, Iwi and Stakeholder Engagement
2.21 The complexity of the work has necessitated a flexible approach, to ensure we work with project partners in a way that works for them, and brings best advice to the project team. Whilst a variety of forums and advice groups have been established, one-to-one engagement is also undertaken with project partners and stakeholders.
Separately to the advice elements, some iwi partners are involved in co-design within specific workstreams. This is separate to tangata whenua inputs on the cultural values assessment, and strives to bring mātauranga Māori advice into the design process.
Project Reference Group
2.22 Further to resolution 4 in section 1.4 above, a Project Reference Group (PRG) has been established. Councillor Brent Barrett joined the PRG as an Elected Member representative in 2022. The membership of the group is included in Attachment 1. The group meets monthly, and Councillors now receive a monthly update approximately one week after the PRG, to reflect the PRG briefing from Councillor Barrett.
2.23 To facilitate the development of Adaptive Management options for the project Jim Bradley (Stantec) and Mike Monaghan (PNCC) have presented on existing Adaptive Management carried out at the PNCC Wastewater Treatment Plant and other techniques used around New Zealand. The PRG attendees have been invited to submit their ideas to the Project Team for investigation.
Ngāti Whakatere
2.24 A Memorandum of Agreement has been developed with Ngāti Whakatere, a hapu of Ngāti Raukawa, which recognises the ongoing effects of waterwater discharges into the river on their hapū. Technical specialists from Ngāti Whakatere will join the Project Technical team to advise on specific interest areas. Ngāti Whakatere have extended an invitation to councillors to visit their marae in Shannon and build relationships now the COVID ‘red settings’ are relaxed to amber. The Project Team is working with the governance team to facilitate this.
Te Tūmatakahuki
2.25 The Project Team have recently met with representatives from Te Tūmatakahuki, a group which represents the coastal hapu of Ngāti Raukawa. Discussions are ongoing to develop an ongoing working arrangement, and work scopes.
Farming Community
2.26 A farm advisor has been appointed to support engagement with the farming community, and to advise on farm management options and costs as the consent development progresses. Regular meetings have been held with Federated Farmers and Food and Fibre representatives from the Project Reference Group, working alongside the Property Group to develop approaches to landowner engagement.
Other Stakeholders
2.27 The project team presented to the Foxton Community Board on 29 January 2022. The team presented on the BPO resolutions, and on the workstreams for this consent stage. The Community Board were pleased that PNCC had selected such a high treatment level for the plant.
2.28 Discussions have commenced with Fonterra, both as a trade waste customer and as representing some elements of the dairy industry locally.
2.29 Horizons Regional Council has invited PNCC to present on the Project in June.
Public information
2.30 Although the consent application development does not have a high level of public engagement required for decision-making, the website has been updated to coincide with the commencement of landowner engagement. The “Nature Calls” branding continues for this consenting stage.
Project Programme
2.31 The draft programme included in the December 2021 Council paper highlighted that the significant amount of work which is required to prepare an application of the required standard cannot be completed in the period prior to 1 June 2022 which is the existing consent target date.
2.32 The inability to meet this deadline is a flow-on effect resulting from COVID-19 delays during the BPO Phase. Condition 23C required that the BPO was lodged in June 2021 and this was delivered to Horizons in September 2021. At the time of development of the consent conditions, there was a 1 year timespan allocated between the BPO decision and the lodgement of consent, presumably to allow sufficient time to develop a good quality consent application. The overall consent to discharge is valid until 2028, presumably to also reflect the significant work required to design and build a new treatment facility after consent is granted.
2.33 The December 2021 paper highlighted the significant work required particularly in respect of the refinement of the land areas, identification of the land areas for assessment as well as the significant engagement with iwi and affected parties. At the time, it was assumed that a lodgement in September, to reflect a 1-year work programme for the consent application was more realistic. The ongoing effects of Covid-19 have impacted the team, both in terms of illness across the supply chain slowing down work, and added difficulties in engagement and face-to-face meetings, including site meetings, through different levels.
2.34 The project team have determined that more time is needed to develop the consent in this context and have estimated a likely project completion of 31 December.
2.35 The issue of the lodgement date was discussed with Rangitāne representatives and they reluctantly agreed to the extension of the programme of works to the 31 December 2022. With their support, contact was made with Horizons Regional Council to advise them of the delay.
2.36 A letter was sent to Horizons on 21 March 2022 to outline the challenges associated with meeting the consent condition 23C relating to the June 2022 lodgement date. This letter detailed the work underway, to demonstrate that work continues to progress on the project in earnest, despite the many challenges associated with the pandemic. Horizons Regional Council has acknowledged the letter and the likely programme delay and is aware of the significant and complex work that Council have done to develop the BPO and progress the consent application.
2.37 Officers sought legal advice from Simpson Grierson. Based on their advice, officers are comfortable that this is a practicable approach to expedite the delivery of the consent application documents.
3. Project Budget
3.1 A consequence of the later lodgement of the resource consent application is the required carry over of capital spend.
3.2 The December Council paper estimated a spend of $2.5M for the FY2021/2022. Spend to date of $754,329 is behind estimated spend for this period, based on the idea that the application will take 6 months longer than originally anticipated.
3.3 The cost analysis is being updated to bring information into the Annual Plan process
4. Project risks
4.1 High priority risks to the Project include are outlined in Table 2 below– the table reflects the unmitigated risks and consequences, and the revised risk after identification and mitigation by the project team
Table 2 – Key Project Risks
|
Risk |
Unmitigated Likelihood |
Unmitigated Consequence |
Mitigated Risk Level |
|
Insufficient Budget |
Likely |
Major |
Moderate Budget requires careful management for a project of this size and scale. An external PM has been appointed |
|
Ability to develop ‘robust’ consent application for December 2022 lodgement |
Likely |
Major |
Moderate Delay from June to December will require careful management due to Land Discharge Area workstream. An external PM has been appointed, plus a land advisor. Project control group meets weekly to review programme and address issues. |
|
External influences resulting in delays (i.e. COVID-19) |
Likely |
Moderate |
Moderate Lessening of alert levels and BAU working resulting is reduced/no further lockdowns. However, the future risks related to Covid 19 cannot be predicted. |
|
Ability to access land for land discharge area testing |
Likely |
Major |
Moderate Lack of land access has ability to impact technical assessment development for consent lodgement. Mitigations include identifications of alternate landowners, and an assumptions-based approach if required |
|
Effects on the mauri of the river and Cultural Effects |
Likely |
Major |
Moderate Being addressed through the various Project forums, requires careful consideration to mitigate cultural effects throughout Project development. High treatment levels are a mitigation |
|
Iwi Relationships |
Likely |
Major |
Moderate Working relationships and agreements being developed. Requires ongoing consideration and management. Project sponsors and senior managers heavily involved in relationship development |
4.2 Project risks will be closely monitored through the Project Control Group and will be reported to Council periodically.
5. Next Steps
5.1 The Project Team will provide quarterly updates to the Council on the development of the consent application.
5.2 Monthly updates will be provided to Council via the Project Reference Group.
|
1. |

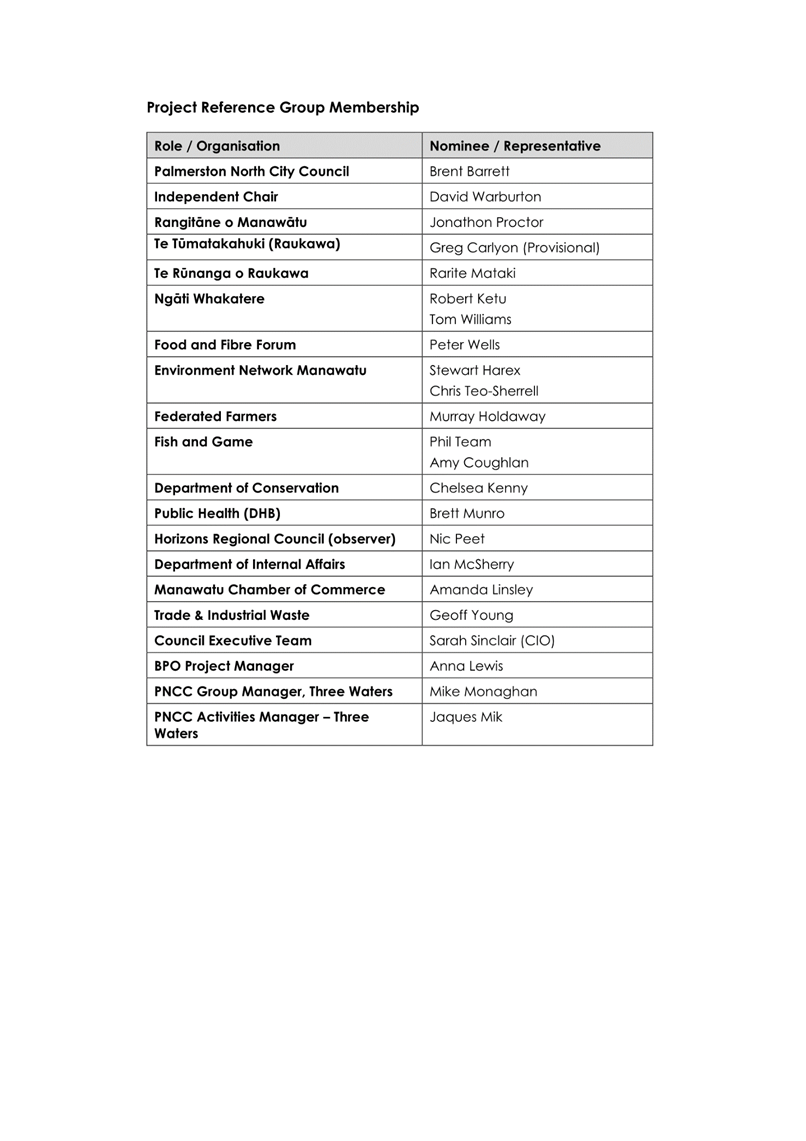

Project Reference Group Membership ⇩ |
|
|
2. |
|
